Kitchen Remodel Timeline: How Long Does It Really Take?

A kitchen remodel usually means 2 to 16 weeks of construction, plus weeks or months of design, permits and ordering before demolition. Here is what happens in each phase and what slows it down.

Kitchen remodel with new drywall and plumbing roughed in, ready for cabinet installation
In this article
  1. Kitchen Remodel Timeline by Scope
  2. What Happens in Each Phase
  3. When to Order Cabinets, Counters and Appliances
  4. What Causes Kitchen Remodel Delays
  5. Living Through a Kitchen Remodel
  6. How Contractors Keep a Kitchen Schedule on Track
  7. How Mr Build Builds a Realistic Kitchen Schedule

Most kitchen remodels take about 2 to 4 weeks of construction for a cosmetic refresh, 6 to 10 weeks for a full remodel that keeps the same layout, and 10 to 16 weeks or more when you move plumbing, gas or walls. Plan on several more weeks to a few months before demolition for design, permits and ordering. The rule that protects every kitchen remodel timeline: finish your selections and order cabinets before the crew starts tearing out.

Below is how the schedule breaks down by scope, what happens in each phase, when to order long-lead items, what causes delays and how to live through it.

Kitchen Remodel Timeline by Scope

The question "how long does a kitchen remodel take" has two answers: how long the crew is in your house, and how long the whole project takes from first meeting to final walkthrough. The second number is always bigger.

ScopeWhat it includesConstruction timeTypical total project
Cosmetic refreshPaint, hardware, counters or backsplash, maybe appliances; same cabinets and layoutAbout 2 to 4 weeksAbout 6 to 10 weeks
Full remodel, same layoutNew cabinets, counters, flooring, lighting and appliances in the same positionsAbout 6 to 10 weeksAbout 3 to 5 months
Layout change or gutMoving the sink, range or walls, new circuits, possibly structural workAbout 10 to 16+ weeksAbout 5 to 9 months

These are typical ranges, not promises. Your city's permit review time, cabinet lead time and the condition of the house all move them. The most common way a 6-week job becomes a 14-week job is a same-layout remodel that turns into a layout change after demolition, for example deciding to move the sink once the old cabinets are out.

If the kitchen work starts pulling in a wall to the family room or the bathroom down the hall, it may make more sense to plan it as a complete home remodel with one schedule, rather than a kitchen with add-ons.

What Happens in Each Phase

Some phases must happen in strict order because each one is inspected or measured before the next can start. Others can overlap if the trades are well coordinated.

Before construction

  1. Design and selections (about 2 to 6 weeks). Layout, cabinets, counters, appliances, plumbing fixtures, lighting, tile and flooring are chosen and documented. Cabinets should be ordered at the end of this phase.
  2. Permits (a few weeks to a couple of months). Any change to plumbing, electrical, gas or structure typically needs a permit. Some simpler work can be permitted quickly, while work that needs full plan check takes longer. Timing depends heavily on the city. In the City of Los Angeles it goes through LADBS; in places like Beverly Hills, Irvine or Newport Beach it goes through the city's own building department. Our guide to kitchen remodel permits in Los Angeles covers what triggers one.

Construction, in order

  1. Protection and demolition (about 2 to 5 days). Floors and adjoining rooms are protected, dust barriers go up, and the old kitchen comes out. This is when hidden problems show up: water damage, old wiring, termite damage, undersized framing.
  2. Rough plumbing, electrical, gas and ventilation (about 1 to 2 weeks). New lines, boxes and ducts go in. This work is inspected before walls close.
  3. Insulation, drywall and floor prep (about 1 to 2 weeks). Walls are closed, taped and textured; subfloor or slab is leveled. New flooring often goes in now so it runs under the cabinets and appliances.
  4. Cabinet installation (about 1 week). It can only start when the cabinets are on site.
  5. Countertop templating and fabrication (about 1 to 3 weeks). Stone and quartz are templated after the base cabinets are installed and level, then fabricated. Painting and some trim can happen during this wait.
  6. Countertop install, backsplash, fixtures and appliances (about 1 to 2 weeks). Sink, faucet, cooktop and lights are connected; tile goes up.
  7. Final inspection and punch list (a few days to 1 week). The building inspector signs off, and you walk the kitchen with the project manager to list small fixes.

Inspections are the least predictable part of the calendar. A rough inspection pushed a few days pushes drywall, which pushes cabinets and everything after. Good scheduling leaves a buffer around each inspection and sends the inspector a job that is ready, so it passes the first time.

When to Order Cabinets, Counters and Appliances

Cabinet lead time is the biggest single variable in a kitchen remodel schedule. Typical ranges:

  • Stock cabinets: often within 1 to 3 weeks, if the sizes and finish you need are in stock
  • Semi-custom: commonly about 4 to 8 weeks
  • Custom: commonly about 8 to 14 weeks or more

Work backward from your target demolition date. If cabinets take 12 weeks and you want to start demolition in March, the design and measurements need to be final around December. Ask the supplier for a written lead time, and treat the order date as the real start of the project.

Other long-lead items to confirm before design is locked:

  • Appliances: check availability for the exact models, since cabinet openings and electrical are built around them. A backordered range can hold up the final inspection.
  • Countertops: choose the slab early, but templating waits for installed cabinets.
  • Special-order tile, plumbing fixtures and lighting: these often take longer than people expect.
  • Windows or doors: if the remodel includes a new window over the sink, it can be the longest lead item of all.

Stock cabinets save weeks but limit sizes and finishes. Custom cabinets give you exact dimensions but require an early, firm decision. Either way, the materials should be ordered, not just chosen, before demolition.

What Causes Kitchen Remodel Delays

Most delays trace back to a short list, and nearly all of them can be reduced with earlier decisions.

  • Selections not finished. A faucet or tile not chosen before demolition can stall a trade. Fix: finalize every selection, down to hardware, before the start date.
  • Design changes after demolition. Moving a sink or adding an outlet after rough-in means rework, reinspection and a change order. Fix: walk the plan carefully before work starts.
  • Late or incomplete permit submittals. Missing details trigger correction rounds. Fix: submit a complete set as soon as design is done.
  • Backorders. Fix: order early and confirm stock before designing around a model.
  • Failed or delayed inspections. Fix: build a few days of buffer around each inspection.
  • Hidden conditions. Water damage, old wiring or termite damage behind cabinets is common in older homes. Fix: keep a contingency in both time and budget; many advisers suggest roughly 10 to 20 percent of the budget for older houses.

Put change order terms in your contract before you sign, so it is clear how a change affects both price and schedule. A good clause says the change is priced and scheduled in writing, and you approve it, before the crew does the work.

If a delay happens, ask for three things: a clear explanation of what is holding up the work, which trades can move earlier to fill the gap, and a revised completion date in writing.

Living Through a Kitchen Remodel

Most families stay home during a kitchen remodel. A temporary kitchen makes the weeks easier:

  • Set up a folding table, microwave, small refrigerator, coffee maker and an electric burner or air fryer in a nearby room before demolition.
  • Use a laundry or bathroom sink for dishes, and stock paper plates for the first couple of weeks.
  • Ask for dust barriers at the kitchen openings and a protected path for the crew.
  • Plan simple meals for demolition week, when dust and noise are heaviest.

A short stay elsewhere can make sense for a long layout change, for households with infants or someone with respiratory problems, or when the remodel also takes your only bathroom offline. Our guide to living at home during a remodel covers containment and when to move out.

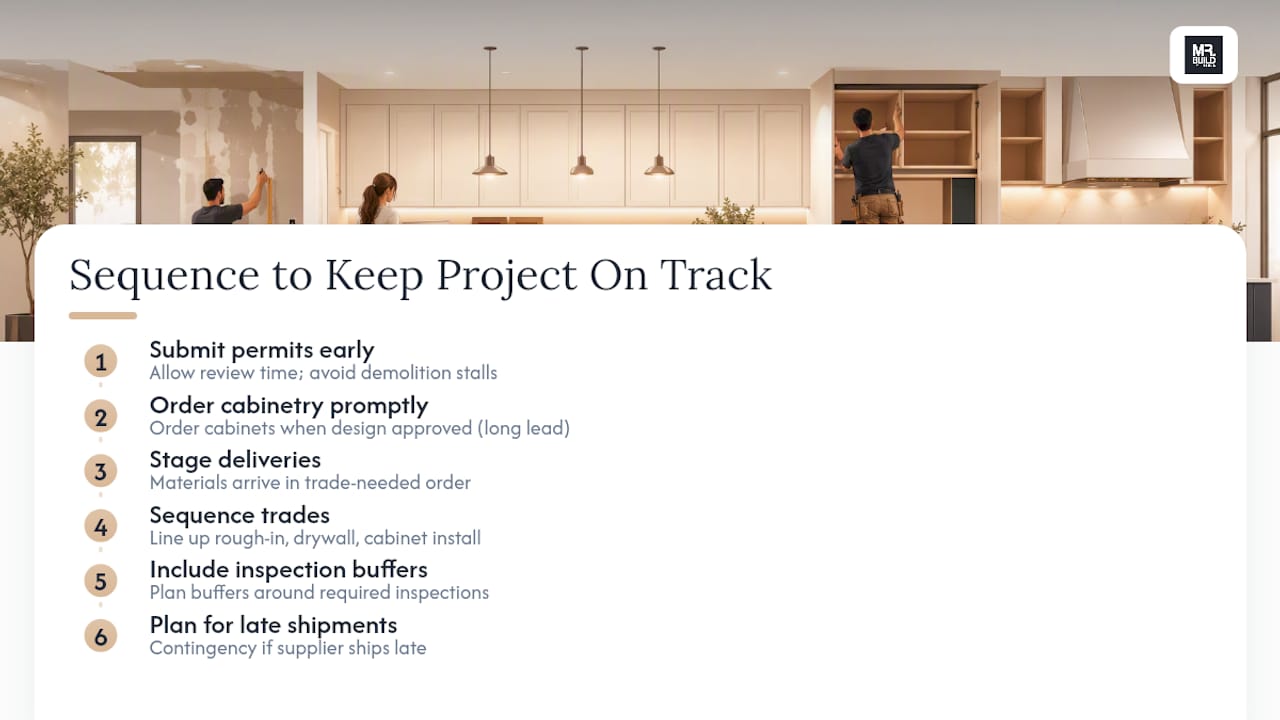

How Contractors Keep a Kitchen Schedule on Track

When you interview contractors, ask how they handle the parts of the schedule that are not in anyone's direct control. Good answers include ordering long-lead items as soon as the design is signed, staging deliveries so materials arrive in the order trades need them, scheduling inspections with a buffer, lining up drywall and cabinet install back to back, and telling you in writing when a date moves.

Also ask who your day-to-day contact is. One project manager who knows the whole schedule catches conflicts before the crew finds them.

How Mr Build Builds a Realistic Kitchen Schedule

Mr Build follows a 5-step process: Consultation, Design and Permits, Selections, Construction and Final Walkthrough. Selections are finished before construction starts, which is the single biggest factor in keeping a kitchen on schedule. Design, plans and permits are handled in-house through our partners, you get a fixed, detailed written scope, and a dedicated project manager coordinates orders, trades and inspections.

Learn more about our kitchen remodeling service, or see how permits and scheduling work for kitchen remodeling in Beverly Hills, where the city runs its own building department and plan review. Bring your target finish date and any selections you have already made, and book a free on-site consultation to get a schedule built around your actual scope.

Sources and further reading

FAQ

Frequently asked questions

How long does a kitchen remodel take?

Construction typically takes about 2 to 4 weeks for a cosmetic refresh, 6 to 10 weeks for a full remodel in the same layout, and 10 to 16 weeks or more when plumbing, gas or walls move. Design, permits and ordering usually add several weeks to a few months before demolition starts, so a full project often spans three to nine months from first meeting to final walkthrough.

When should I order kitchen cabinets?

Order cabinets as soon as the design and measurements are final, ideally so they arrive before demolition or shortly after rough-in passes. Stock cabinets can ship within a few weeks, semi-custom often takes about 4 to 8 weeks and custom cabinetry commonly takes 8 to 14 weeks or longer. Ask your supplier for a written lead time and add a buffer.

What causes the most kitchen remodel delays?

The usual causes are late decisions on cabinets, appliances or fixtures, design changes after demolition, slow or failed inspections, backordered materials and hidden damage behind walls or under floors. Nearly all of these are reduced by finishing selections before demolition, ordering long-lead items early and keeping a time and money contingency for what the walls reveal.

Can I live at home during a kitchen remodel?

Most people do. Set up a temporary kitchen in another room with a microwave, a small fridge, an electric burner or air fryer and a folding table, and use a bathroom or laundry sink for dishes. Ask your contractor for dust barriers at the kitchen openings. A larger remodel that also affects bathrooms or utilities may make a short stay elsewhere worth it.

From the blog

Keep reading

Free estimate

Let's talk about your home

Share a few details and we'll set up a visit. We'll look at the space, listen to what you want, and explain how permits, schedule and budget would work for your project.

  • On-site visit with an experienced builder
  • Clear written scope and pricing
  • Design, engineering and permits handled for you
