A typical home remodel timeline runs a few weeks for a cosmetic refresh, two to four months for a kitchen or bathroom, and about 6 to 12 months for a whole-home remodel, plus time beforehand for design and permits. The finish date depends less on how fast the crew works and more on how quickly decisions are made, how complete the permit submittal is and whether materials arrive on time.
The better way to plan is by milestones rather than calendar dates: permit issued, demolition complete, rough inspections passed, drywall done, cabinets set, final walkthrough. This guide lays out how long each phase usually takes, the order it happens in, what you need to decide and when, and the delays worth planning around.
Home remodel timeline by project scope
These are typical ranges for Los Angeles area projects. Each one has two parts: preconstruction (design, selections and permits) and construction (demolition to final inspection).
| Scope | Preconstruction | Construction |
|---|---|---|
| Cosmetic refresh: paint, flooring, fixtures, no permit | 1 to 3 weeks | 2 to 6 weeks |
| Bathroom remodel | 1 to 2 months | 6 to 12 weeks |
| Kitchen remodel | 1 to 3 months | 8 to 16 weeks |
| Multi-room remodel | 2 to 4 months | 3 to 6 months |
| Whole-home gut remodel | 2 to 6 months | 6 to 12 months or more |
When a contractor quotes a duration, ask what the clock includes. Some quotes start at permit submittal, others at demolition, and some leave out the punch list. Two schedules that look the same on paper can differ by a couple of months.
For room-specific detail, see our kitchen remodel timeline.
The phases of a remodel, in order

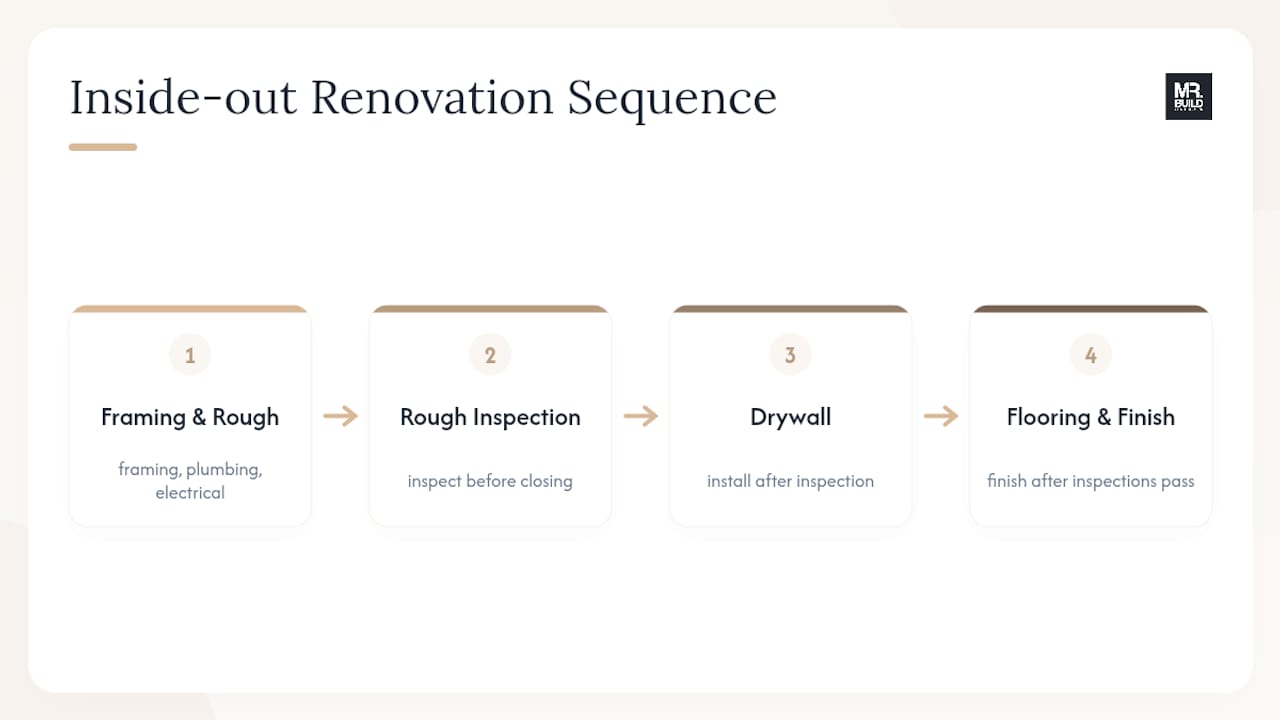

Remodels follow a structural-to-cosmetic sequence: everything hidden inside the walls goes in and gets inspected before anything that covers it.
- Consultation and scope: a site visit, measurements, goals and a working budget.
- Design and engineering: floor plans, structural details if walls or beams change, and Title 24 energy documents if required.
- Permits: plan check with the city, corrections and permit issuance. Simple projects may qualify for faster review; projects with structural changes go through full plan check.
- Selections and ordering: cabinets, windows, tile, fixtures and appliances chosen and ordered.
- Demolition: finishes, cabinets and fixtures come out, and hidden conditions come to light.
- Structure and framing: new walls, beams, openings and any foundation work.
- Rough trades: plumbing, electrical, HVAC and low-voltage lines run through open walls.
- Rough inspections: the city inspects framing and rough trades before anything is covered.
- Insulation and drywall: insulation is inspected where required, then drywall is hung, taped and finished.
- Finishes: cabinets, countertops, tile, flooring, paint, trim, fixtures and appliances.
- Final inspection, punch list and closeout: city sign-off, corrections, cleaning and documents.
Inspections are hard gates. Work behind a wall cannot be covered until it passes, and covering it early means opening it back up. A good schedule plans each inspection a few days ahead so the crew is never waiting.
What you decide, and when
Most avoidable delays come from decisions made too late. Each choice has a deadline tied to a phase, not to when it is convenient.
| Decision | Make it by | Why |
|---|---|---|
| Layout, wall changes, window locations | Before permit submittal | They are on the permit drawings |
| Cabinets and appliances | Before or at permit submittal | Long lead times; they set plumbing and electrical locations |
| Plumbing fixtures and shower valves | Before rough plumbing | Valve bodies and drain locations go in at rough-in |
| Lighting plan and switch locations | Before rough electrical | Boxes and wiring go in before drywall |
| Tile, flooring and countertop material | Before demolition | Lead times, and substrate prep depends on the choice |
| Paint colors, hardware, accessories | Before finishes begin | Short lead, but easy to forget |
What causes remodel delays
Permit review
Plan check is the least predictable part of the schedule. An incomplete or unclear submittal triggers correction rounds, and each round adds weeks. Submitting complete drawings, structural calculations and energy documents together, then answering comments quickly, is the best protection.
Long-lead materials
Custom cabinetry, special-order windows and doors, some appliances and imported tile can take many weeks to arrive. Order them as soon as the design is final, inspect each delivery on arrival, and pick a backup for anything at risk of backorder.
Hidden conditions
Demolition reveals what drawings cannot: rot, termite damage, old wiring, undersized framing or plumbing that does not meet current code. Each discovery needs a decision and often a change order. Older homes in Los Angeles are more likely to have these surprises, so plan schedule buffer and a contingency for them.
Inspections and trades
A failed inspection means a fix and a re-inspection. Subcontractor conflicts, where one trade is waiting on another, add small delays that compound. Weather mostly affects exterior work, roofing and additions.
Example: a whole-home remodel, month by month
Here is how a typical whole-home remodel of a single-story Los Angeles house with some wall changes, a new kitchen and two bathrooms might unfold. Every project differs, but the shape is consistent.
| Months | What happens |
|---|---|
| 1 to 2 | Site visit, measurements, design, structural engineering for removed walls |
| 2 to 4 | Plan check and corrections; selections finalized; cabinets and windows ordered |
| 4 to 5 | Demolition, hidden-condition repairs, framing and beam work |
| 5 to 6 | Rough plumbing, electrical and HVAC; rough inspections; insulation |
| 6 to 7 | Drywall, tile, cabinets, countertop templating |
| 7 to 9 | Countertops, flooring, paint, fixtures, appliances, final inspection, punch list |
The construction phase in this example runs about five months, but the whole project runs closer to nine. That is why the preconstruction months deserve as much attention as the build.
How to shorten your remodel timeline
You cannot speed up concrete curing or a city review queue, but you can remove most of the waiting around them:
- Finish design before you submit. Changing drawings during plan check restarts parts of the review.
- Answer correction comments within days, not weeks. The review clock pauses while the city waits on you.
- Make selections on a schedule. A written list of every decision, with a due date, prevents trades from stopping mid-phase.
- Order long-lead items at permit submittal. Materials should be waiting for the crew, not the other way around.
- Open up suspect areas early. A small inspection hole in a wall or a look in the crawl space before demolition can reveal problems while there is still time to plan.
- Limit mid-project changes. Each change order adds pricing, approval and often a re-inspection.
Milestones that tell you where you really are
Track the project against these checkpoints. Each one unlocks the next phase.
- Permit issued: legal approval to start work.
- Demolition complete: hidden conditions are known; structural work can start.
- Rough inspections passed: insulation and drywall can proceed.
- Drywall complete: finish trades can begin.
- Cabinets set: countertops can be templated, which often takes one to three weeks to fabricate.
- Countertops installed: sinks, faucets, backsplash and appliances follow.
- Final inspection passed: punch list and closeout begin.
Plan family events, move-back dates and deliveries around milestones, not guessed dates. A weekly check-in with your project manager to review the next two milestones keeps surprises small.
Living at home during a remodel
A cosmetic job or a single bathroom usually lets you stay with modest disruption. A kitchen remodel means weeks without a working kitchen, so set up a temporary station with a refrigerator, microwave and a sink nearby. A whole-home gut, or any project that shuts off water or power for long periods, usually means moving out for the heaviest phases.
If you stay, agree on dust barriers, a protected walking path, work hours and a no-go zone for kids and pets. Our guide to living in your home during a remodel has more practical detail.
Punch list and closeout
Near the end, walk each room with your project manager and list every item that needs attention, with its exact location and a photo. Specific notes such as "scuff on north wall, left of window" get fixed faster than "touch up paint."

Understand the difference between substantial completion, when the space is usable, and final completion, when every punch item is done. Before final payment, confirm the final inspection is signed off and collect lien releases for the work paid.
Gather the closeout package before the crew leaves:
- Permit card with final sign-off
- Appliance manuals and product warranties
- Paint colors and finish product names
- Photos of open walls taken before drywall, showing plumbing and wiring
- Updated drawings if walls or systems moved

How Mr Build keeps a remodel on schedule
Mr Build Co. runs every remodel through the same five steps: Consultation, Design & Permits, Selections, Construction and Final Walkthrough. Selections are locked and long-lead items ordered before demolition, permits are prepared and submitted in-house through our partners, and a dedicated project manager schedules trades and inspections against milestones. You get a fixed, detailed written scope, so the schedule is built on the same plan as the price. Learn more about our complete home remodeling services or our work as a home remodeling company in Brentwood, then schedule a free consultation to map a realistic timeline for your house.
Sources and further reading
- remodelcalculators.com: home remodel planning guide remodelcalculators.com
- comparable renovation timelines howlongfor.com
- a common cause of multi-week setbacks bobvila.com
- together they add up houzz.com
- westonbuildersinc.com: phased remodel schedule home renovation timeline guide westonbuildersinc.com
- The Connected Dwelling theconnecteddwelling.com
