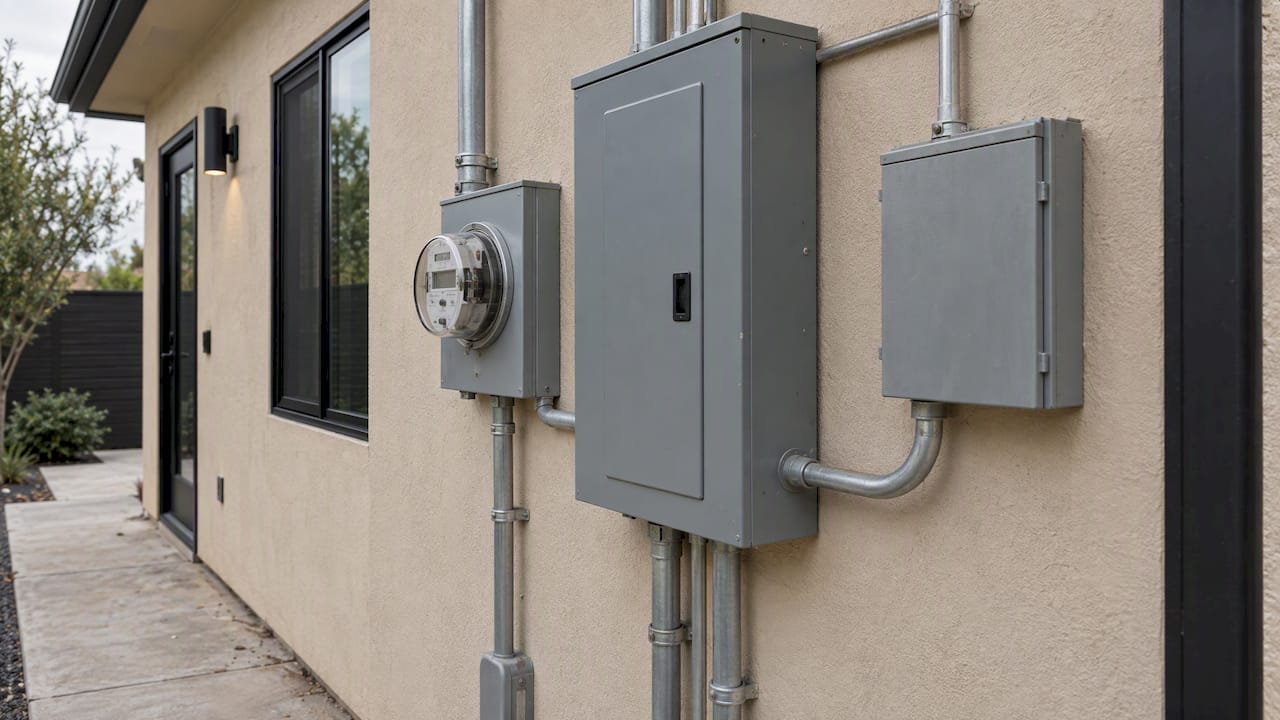

Most ADUs connect to the utilities that already serve the main house. Electricity usually runs from the main service to a subpanel in the ADU, or to a separate meter where the utility allows it. Water typically branches off the existing service, since utilities like LADWP generally will not add a second water meter to a single-family lot. Sewer ties into the existing lateral or a new connection, and gas is optional, with many new ADUs built all-electric. Utilities energize new service only after the city's final inspection.
The ADU utilities connection is easy to underestimate. A panel without spare capacity, a cracked sewer line or a long trench to the back of the lot can change the budget by a wide margin, and it is far cheaper to find these at the start than during construction. This guide covers each utility in the order we check them.
Shared or Separate: How ADU Utilities Usually Connect
| Utility | Common approach | Separate option | Key question |
|---|---|---|---|
| Electric | Subpanel fed from the main service | Separate meter, if the utility allows | Does the main service have spare capacity? |
| Water | Branch line from the existing service | Rarely allowed on single-family lots; private sub-meter instead | Is the line big enough, including for sprinklers? |
| Sewer | Tie into the existing lateral | New lateral to the street, where needed | What condition is the lateral in, and does it slope enough? |
| Gas | Often none: all-electric design | Branch from house piping or a new meter | Is gas worth the trench and the cost? |
| Internet and cable | Conduit from the house or street | Separate service account | Is there an empty conduit in the trench? |
Electrical: Panel Capacity Comes First

The first electrical question is how much capacity your existing service has left. Many older Los Angeles homes have 100-amp service, and some have even less. Newer and upgraded homes often have 200 amps. An electrician runs a load calculation that adds up the main house's demand and the ADU's planned loads, then compares the total to the service rating.
The result points to one of three paths:
- Subpanel from the existing service. If there is enough headroom, a feeder runs from the main panel to a subpanel in the ADU. This is the simplest and least costly option.
- Service upgrade. If capacity is short, the main service is upgraded, often to 200 amps or more. That involves a new panel and meter socket, an application to the utility and sometimes new service wires from the pole or an underground line.
- Separate meter. Some utilities allow a separate meter for the ADU, which simplifies tenant billing. Requirements differ, so confirm with the utility before designing around it.
In the City of Los Angeles, LADWP provides electricity. Many surrounding cities are served by Southern California Edison. Each has its own application and scheduling process for service changes, and the meter is set or released only after LADBS or the local building department signs off the electrical work.
Plan for electric loads you will add later
Size the service for where the property is heading, not just today. Heat pumps, induction ranges, EV chargers and heat pump water heaters all add load. Upgrading once during ADU construction costs less than upgrading again in a few years.
Solar and the energy code
California's energy code generally requires solar panels on newly constructed detached ADUs, with some exceptions such as heavy shading. Conversions and attached ADUs are usually treated differently. Your energy consultant confirms what applies, and the California Energy Commission publishes the standards at energy.ca.gov. Our post on the California solar mandate explains the details.
Water: Usually One Meter, Sized Correctly
Many homeowners assume a new unit gets its own water meter. On most single-family lots it does not. LADWP's policy generally does not provide a second water meter and service to a single-family property that already has one, so the ADU branches off the existing line after the meter.
What matters then is size and pressure. The plumber checks that the existing service can supply the added fixtures. If the ADU needs fire sprinklers, which can be triggered by distance from the street or fire hydrant, the water service may need to be larger to support them. That can mean a bigger meter or a new line, so ask early.
If you plan to rent the ADU and want to bill water separately, a private sub-meter on the ADU's branch line lets you track use. Our guide to ADU rental income covers how utility splits fit into a lease.
Sewer: Check the Lateral Before You Design
The sewer lateral is the pipe that carries waste from the house to the city main, usually under the yard and driveway. Many Los Angeles homes still have original clay or cast iron laterals that are cracked, offset or full of roots. Tying a new ADU into a failing line is a problem waiting to happen.
- Camera inspection. A video scope of the lateral shows its condition and route. We recommend it before design, not after.
- Slope. Sewer lines flow by gravity, so the ADU's drain has to sit high enough to fall to the lateral. A unit lower than the connection point may need a pump system.
- Route. The new line should avoid foundations, trees and easements where possible.
- Cleanouts. Accessible cleanouts are required so the line can be serviced.
- City review. LA Sanitation and LADBS review sewer connections, and sewer-related fees may apply to a new unit.
Lots on septic systems face a separate review of the tank and leach field, which can limit where the ADU sits.
Gas: Optional, and Often Skipped
Gas is the one utility many new ADUs leave out. An all-electric ADU with a heat pump for heating and cooling, a heat pump water heater and an induction range avoids a gas trench, a meter and gas piping inspections. In Los Angeles, the city has adopted rules that push new construction toward all-electric design, so confirm current requirements with LADBS before planning a gas line.
If you do want gas, it usually branches from the house's piping after a check that the meter and line can carry the extra load. A new or upgraded gas service goes through SoCalGas in most of Southern California. Only the gas utility or its authorized contractors make the final connection to its system, and the meter is set after the house-side piping passes inspection.
Connection Fees and What State Law Limits
State ADU law limits what cities and utility districts can charge:
- ADUs created within an existing structure, and junior ADUs, generally cannot be required to have a new or separate utility connection, and cannot be charged a connection fee or capacity charge for one.
- New detached ADUs can be required to have a new connection, but connection fees and capacity charges must be proportional to the burden the unit adds, based on its size or plumbing fixtures.
- ADUs under 750 square feet are exempt from impact fees.
These limits do not cover the cost of the work itself, such as trenching, pipe, wire and panels, which is often the larger part of the budget.
The Order Utility Work Happens In
- Early site assessment. Photograph the panel and meter, run a load calculation, scope the sewer lateral and locate the water line.
- Design around the findings. Place the ADU and route the trench with utilities in mind, and decide on gas, metering and any service upgrade.
- Permits and utility applications. Building, electrical, plumbing and mechanical permits go through plan check, and service upgrade requests go to the utility in parallel.
- Trenching and rough-ins. Lines are run, often in a shared trench with proper separation, plus an empty conduit for internet.
- Inspections. Underground work is inspected before backfill, and rough-ins before walls close.
- Final and energize. After the final inspection, the utility sets any new meter and energizes the service.
Utility scheduling has its own lead time, so the request should be in well before construction wraps up. For the full permit sequence, see our guide to getting an ADU permit in Los Angeles.
Common Mistakes With ADU Utility Connections
- Skipping the load calculation and finding out mid-project that the service must be upgraded
- Designing around a second water meter the utility will not provide
- Tying into an old sewer lateral without a camera inspection
- Forgetting fire sprinkler water demand on lots far from the street
- Routing a trench through a tree's root zone or an easement
- Waiting until the end of construction to request a meter or service change
How Mr Build Handles ADU Utility Connections
Mr Build Co. has delivered more than 50 ADUs, and utilities are part of every scope we write. We check panel capacity, sewer condition and water service during the free site visit, design the ADU around what we find, and handle permits and approvals through our in-house team and partners. Your fixed, detailed written scope includes the connections, and a dedicated project manager coordinates inspections and utility scheduling.
Learn more about our ADU and addition services and our work in Los Angeles, or book a free on-site consultation to find out what your property's utilities can support.
