How to Get an ADU Permit in Los Angeles: Steps, Costs and Timeline

An ADU permit in Los Angeles comes from LADBS after zoning review, plan check and clearances. Here is each step in order, with the documents and decisions that keep it moving.

Contractor measuring a backyard site for a new ADU in Los Angeles
In this article
  1. First, Confirm Who Issues Your Permit
  2. What the City Checks on an ADU Permit
  3. The ADU Permit Process in Los Angeles, Step by Step
  4. Documents for an ADU Permit Package
  5. Clearances From Other City Departments
  6. How Long an ADU Permit Takes in Los Angeles
  7. Inspections During Construction
  8. What Drives ADU Permit Fees
  9. Why ADU Applications Get Sent Back
  10. What to Ask Before You Hire Help
  11. How Mr Build Handles ADU Permits in Los Angeles

To get an ADU permit in Los Angeles, you confirm what your lot allows, prepare plans (custom or from the LADBS Standard Plan Program), submit them to the Los Angeles Department of Building and Safety for plan check, clear any required reviews from other city departments, and then pass a series of inspections during construction. State law requires the city to approve or deny a complete ADU application within 60 days, but that clock starts only once the package is complete.

Most of the delays we see come from two places: starting design before checking the lot, and submitting drawings that are missing pieces. This guide covers each step in the order it happens, so you know what to decide and when.

First, Confirm Who Issues Your Permit

LADBS issues ADU permits for properties inside the City of Los Angeles, including Brentwood, Pacific Palisades, Encino and the rest of the city's neighborhoods. Los Angeles City Planning sets the zoning rules LADBS checks against.

Not every address with "Los Angeles" in it is in the city. Unincorporated areas are permitted by Los Angeles County Public Works through the county's own online system, and incorporated cities like Beverly Hills, West Hollywood and Manhattan Beach run their own building departments. Confusing these is common, and it leads to reading the wrong rules. City Planning's ZIMAS parcel lookup shows your jurisdiction, zone and overlays.

What the City Checks on an ADU Permit

An ADU permit in Los Angeles is reviewed against state ADU law, the city's zoning code and the building code. These are the rules that shape most designs:

  • Size. Detached ADUs can generally be up to 1,200 square feet. Attached ADUs are limited relative to the size of the main home, with a state guarantee that allows at least an 800-square-foot unit on most lots.
  • Setbacks. New detached ADUs need 4-foot side and rear setbacks under state law. Front setbacks follow local rules. Our post on ADU setbacks in Los Angeles goes deeper.
  • Height. Detached ADUs are typically allowed at least 16 feet, with more height allowed in some cases, such as near major transit. Attached ADUs can usually match the main house's zone height up to a state cap.
  • Parking. At most one space, and often none. See our guide to ADU parking requirements in Los Angeles.
  • Fire and access. Distance to a fire hydrant, street width and hose-pull distance from the street can trigger fire sprinklers or other requirements.
  • Building and energy code. Structure, egress, insulation and Title 24 energy compliance, including solar for many new detached units.

The ADU Permit Process in Los Angeles, Step by Step

  1. Site check. Pull the zoning, overlays, permit history and any easements. Look at the electrical service, sewer line location and access for equipment.
  2. Choose a design path. Decide between a custom design and an LADBS pre-approved standard plan, and between detached, attached, garage conversion or junior ADU.
  3. Prepare plans. Architectural drawings, structural plans and calculations, and Title 24 energy documents. Add a survey and soils report if the lot needs them.
  4. Submit for plan check. Residential ADU plans are usually filed electronically through LADBS's ePlanLA system, and plan check fees are paid at submittal.
  5. Clearances. Other departments sign off where your lot requires it, as described below.
  6. Corrections. The plan checker issues comments. Your designer revises and resubmits. A well-coordinated set often clears in one or two rounds.
  7. Permit issuance. Remaining fees are paid and the building permit is issued, along with electrical, plumbing and mechanical permits.
  8. Construction and inspections. LADBS inspects at each stage before work is covered.
  9. Final inspection. Once the final passes, the ADU is legal to occupy.

The LADBS Standard Plan Program

LADBS maintains a library of ADU designs that have already passed building code review. Choosing one can shorten plan check and cut design costs, because the reviewer focuses on site-specific items instead of the whole building. The plan still has to fit your lot. You will need a site plan, a zoning check, a foundation suited to your soil and slope, and utility connection details. If the standard footprint does not fit your setbacks or the shape of your yard, a custom design is often the faster route overall.

Conversions versus new construction

Converting an existing garage or accessory building is usually the simpler permit. The structure is already on the lot, so new setbacks generally do not apply as long as you stay within the existing footprint, and no replacement parking is required. Review then focuses on what changes: a new or reinforced slab, insulation, windows for egress, fire separation and new plumbing. A new detached ADU needs a full foundation design, utility trenching and the complete set of zoning checks, so expect more drawings and a longer review.

Documents for an ADU Permit Package

  • Site plan with property lines, setbacks, existing structures, the ADU footprint and utility routes
  • Floor plans, elevations, sections and roof plan
  • Structural drawings and calculations stamped by a licensed engineer
  • Title 24 energy compliance forms
  • Survey, if property lines are unclear or the ADU is close to the 4-foot setback
  • Soils or geology report for hillside lots or where the engineer requires one
  • For garage conversions, drawings of the existing structure and what changes

Clearances From Other City Departments

Depending on the lot, LADBS may need sign-offs from other departments before it issues the permit.

DepartmentWhat it typically reviews
City PlanningZoning, overlays, historic districts and specific plans
Fire DepartmentHydrant distance, access from the street, fire zones
LA SanitationSewer connection and capacity
Bureau of EngineeringStreet dedications and work in the public right-of-way
LADWPWater and electric service
Urban ForestryProtected trees near the work

Hillside lots in Very High Fire Hazard Severity Zones face added limits on new ADUs, so check early if your property is in one. Coastal-zone parcels, including parts of Pacific Palisades, may need a Coastal Development Permit. Homeowners in the Palisades rebuilding after the January 2025 fire should confirm current rebuild and ADU procedures directly with LADBS.

How Long an ADU Permit Takes in Los Angeles

The 60-day state deadline covers the city's review of a complete application. The whole path from first sketch to permit in hand is longer. As a rough planning guide:

  • Site check and survey: two to four weeks
  • Design and engineering: one to three months, faster with a standard plan
  • Plan check, corrections and clearances: one to three months for a typical flat lot
  • Construction: roughly four to eight months for many detached ADUs, less for a simple conversion

Hillside, coastal and historic properties add time. So do slow answers to correction letters, which is why we track every comment until it is closed.

Inspections During Construction

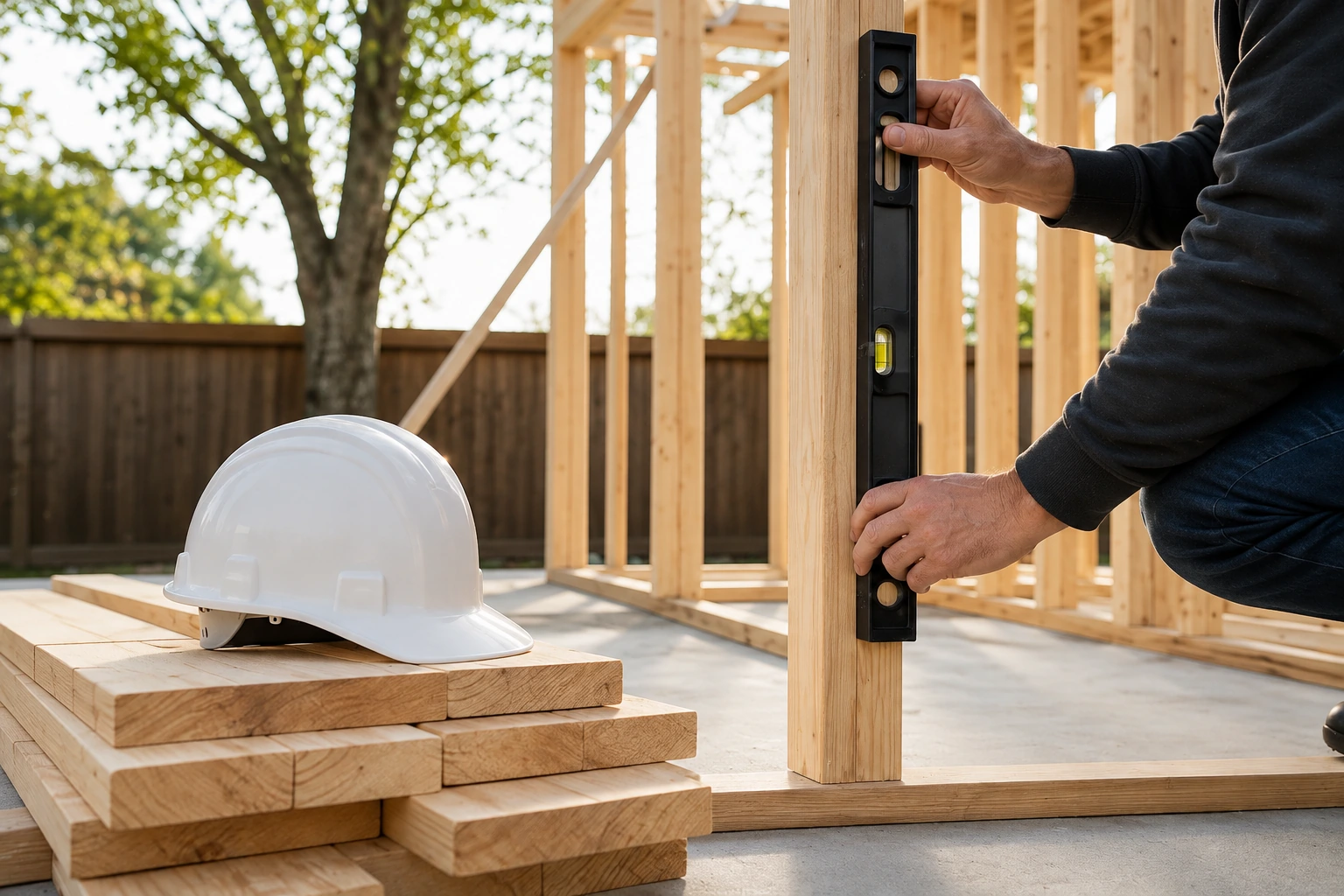

Builder checking wall framing and connections on a new ADU before inspection

LADBS inspects the work in stages, and each stage has to pass before it is covered up:

  1. Foundation forms and reinforcing steel before the pour
  2. Framing, shear walls and hold-downs
  3. Rough electrical, plumbing and mechanical
  4. Insulation
  5. Drywall nailing
  6. Final inspection of the finished unit

Covering work before it is inspected can mean opening walls or slabs later. If the ADU will have its own utility meter or a separate entrance from the street, ask early whether it needs its own address, since that needs to be settled before the final.

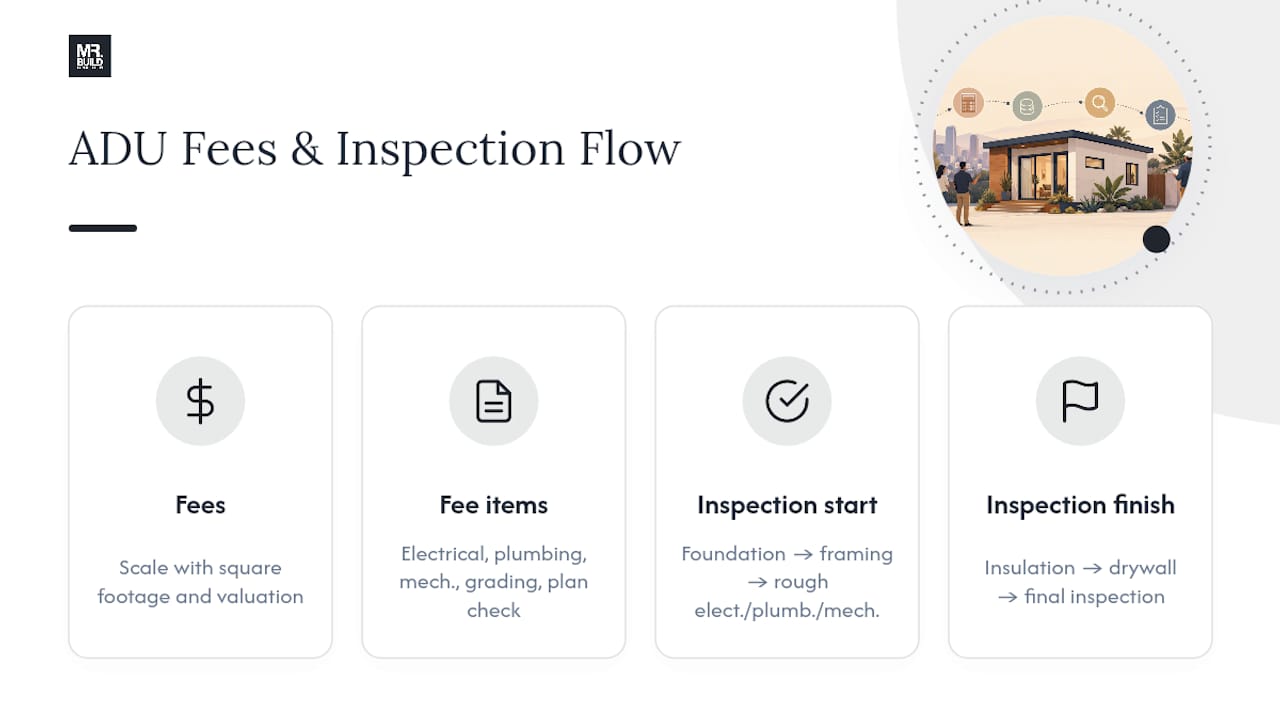

What Drives ADU Permit Fees

LADBS fees scale with the size and valuation of the project and the number of trade permits. Other fees depend on the unit:

  • ADUs under 750 square feet are exempt from impact fees under state law.
  • School district fees can apply to ADUs over 500 square feet.
  • Sewer and utility connection fees may apply to new detached units, while conversions and junior ADUs are generally protected from new connection fees.

For how utilities affect the budget and schedule, see our guide to ADU utility connections.

Why ADU Applications Get Sent Back

  • Structural calculations that do not match the architectural drawings
  • A standard plan dropped onto a lot without checking slope, setbacks or soil
  • Missing Title 24 energy documents
  • Site plans without dimensions to property lines and between buildings
  • Fire access or hydrant distance not addressed
  • Utility routes left undecided until late in the process

What to Ask Before You Hire Help

Some firms only produce plans, others only build, and some do both. Before you sign, ask:

  • Do you hold a California contractor license, and is it active? You can check any license at cslb.ca.gov.
  • Who prepares the plans and engineering, and who answers plan check corrections?
  • Is your price a fixed written scope, or an estimate that changes after plan check?
  • Who coordinates utilities and inspections during construction?

Permit rules and procedures change, so confirm current requirements with LADBS before you finalize your design.

How Mr Build Handles ADU Permits in Los Angeles

Mr Build Co. is a design-build contractor, in business since 1984, licensed under California license #439166, with more than 50 ADUs delivered. Our ADU team handles design, plans, engineering, permits and approvals through in-house staff and partners, then builds the unit, so the same project manager follows your ADU from the first site visit to the final walkthrough. You get a fixed, detailed written scope before construction begins.

See our work across Los Angeles, or book a free on-site consultation and we will tell you what your lot supports and what a realistic permit timeline looks like.

Sources and further reading

FAQ

Frequently asked questions

How long does it take to get an ADU permit in Los Angeles?

State law requires the city to approve or deny a complete ADU application within 60 days. In practice, the full process from design to permit often takes three to six months, because design, engineering, correction rounds and clearances from other departments all take time. Hillside, coastal and historic lots usually take longer.

Do LADBS pre-approved ADU plans save time?

They can. The LADBS Standard Plan Program lets you choose a design that has already passed building code review, so plan check focuses on site-specific items. You still need a site plan, zoning review, foundation design for your soil and utility connections. If the plan does not fit your lot or setbacks, a custom design may be the better choice.

Can I build an ADU on any lot in Los Angeles?

Most single-family and multifamily lots in the City of Los Angeles can have at least one ADU and often a junior ADU. Some lots face added limits, such as hillside properties in Very High Fire Hazard Severity Zones, lots with narrow substandard street access, or parcels with easements where the unit would go. Check your parcel in ZIMAS and confirm with City Planning or LADBS.

Do I need to live on the property to permit an ADU in Los Angeles?

No. California law no longer allows cities to require that the owner live on site for an ADU. A junior ADU is different: the owner must live in either the main house or the JADU. You can rent an ADU long term, but short-term rental of ADUs is generally restricted.

From the blog

Keep reading

Modern ADU behind a West Hollywood home with a car parked in the driveway

ADUs & AdditionsOctober 20, 2026

West Hollywood ADU Parking Rules: What You Need to Know

West Hollywood does not require off-street parking for an ADU, even when you convert the garage. The real decisions are about your own cars, your future tenant and the street outside.

Free estimate

Let's talk about your home

Share a few details and we'll set up a visit. We'll look at the space, listen to what you want, and explain how permits, schedule and budget would work for your project.

  • On-site visit with an experienced builder
  • Clear written scope and pricing
  • Design, engineering and permits handled for you

Prefer to call? 888-792-8453

Get Free Estimate

We reply within one business day. No obligation.
Call nowGet Free Estimate
