Grading Permit in Los Angeles: When You Need One and How It Works

If your project cuts into a slope, brings in fill or needs a retaining wall, plan on a grading permit. Here is how the LADBS process works and where projects lose time.

Hillside home site in Los Angeles cleared and staked for grading with excavation equipment on the pad
In this article
  1. When a Los Angeles project needs a grading permit
  2. Why hillside lots are different
  3. Documents a grading permit application needs
  4. How the LADBS grading process works
  5. Grading bonds for hillside work
  6. Haul routes, neighbors and timing
  7. Inspections, erosion control and permit expiration
  8. Common reasons grading plans get sent back
  9. How Mr Build helps with grading and site work

In Los Angeles, you generally need a grading permit when a project excavates, adds fill or reshapes the ground beyond small, shallow work, and almost always when it involves a hillside lot, a retaining wall that holds back soil, a basement or a new building pad. In the City of Los Angeles the permit comes from LADBS, and in hillside areas the soils and geology work is reviewed by its Grading Division.

Grading is usually the first approval on a new home, a large addition or a rebuild, and the building permit often waits on it. This guide explains what triggers a grading permit in Los Angeles, which reports you need, when a bond or haul route applies, and how to keep it from holding up the rest of the job.

When a Los Angeles project needs a grading permit

Grading means excavation, fill or both. That covers cutting a pad into a slope for a new house, filling a low corner of a yard, digging for a basement and building up soil behind a retaining wall. The code exempts some minor work, such as small, shallow excavations on level ground that do not change drainage, but the thresholds are technical and hillside lots are treated more strictly.

Projects that almost always need grading review:

  • A new custom home or rebuild that creates or enlarges a building pad
  • Retaining walls that support a cut or fill
  • Basements, subterranean garages and deep foundations near property lines
  • Pools, spas and yard terracing on hillside lots
  • Slope repair after erosion, a slide or a failed wall
  • Any work that redirects how stormwater leaves the lot

If you are unsure, describe the work, the depth and an estimated volume to LADBS before you start. A builder or civil engineer can estimate cut and fill quantities from a topographic survey.

City of LA or county?

Brentwood, Pacific Palisades, Encino and the rest of the City of Los Angeles go through LADBS. Unincorporated areas of the county go through Los Angeles County Public Works, and other cities such as Beverly Hills or Manhattan Beach have their own building departments with their own grading rules. Check your parcel's jurisdiction first, because the forms, fees and review steps differ.

Why hillside lots are different

Much of the Santa Monica Mountains side of the city, including large parts of Brentwood, the Palisades and the hills above Encino, sits in designated hillside areas. On these lots the city looks harder at slope stability, drainage and how much earth leaves or enters the site.

  • Reports: a geology report and a soils report (often combined) are typically required for grading in a hillside grading area.
  • Grading limits: the city's Baseline Hillside Ordinance, administered with LA City Planning, limits grading quantities on many single-family hillside lots based on lot size. Confirm your lot's limits on planning.lacity.gov or with a planner early, because they can shape the house design.
  • Bonds: larger hillside grading requires a bond, covered below.
  • Haul routes: importing or exporting more than 1,000 cubic yards in a hillside grading area requires haul route approval with a public hearing.

For Pacific Palisades owners rebuilding after the January 2025 fire, grading is often part of the rebuild: damaged retaining walls, eroded slopes and pads that need to be re-certified. The city and state put special rebuild procedures in place, and they have changed over time, so confirm the current rules with LADBS before planning the sequence of your project.

Documents a grading permit application needs

A complete first submittal is the single biggest factor in how fast grading plan check moves. Expect to prepare:

DocumentPrepared byWhat it shows
Topographic surveyLicensed land surveyorExisting contours, property lines, structures, trees and drainage
Soils (geotechnical) reportGeotechnical engineerBorings, soil type, expansion potential, compaction and foundation recommendations
Geology reportEngineering geologistBedrock, landslide and slope stability conditions, usually required on hillside lots
Grading and drainage planCivil engineerProposed grades, cut and fill volumes, cross-sections, retaining walls, drainage devices
Erosion control planCivil engineerHow sediment stays on site during construction, especially in the rainy season
Stormwater or LID planCivil engineerHow runoff is captured or treated for new development, where required

The soils and geology reports drive the rest. Their recommendations for footing depth, keyways, subdrains and compaction get built into the grading plan and the structural design. Submitting the reports with the plans, rather than after a reviewer asks for them, avoids a full extra review round.

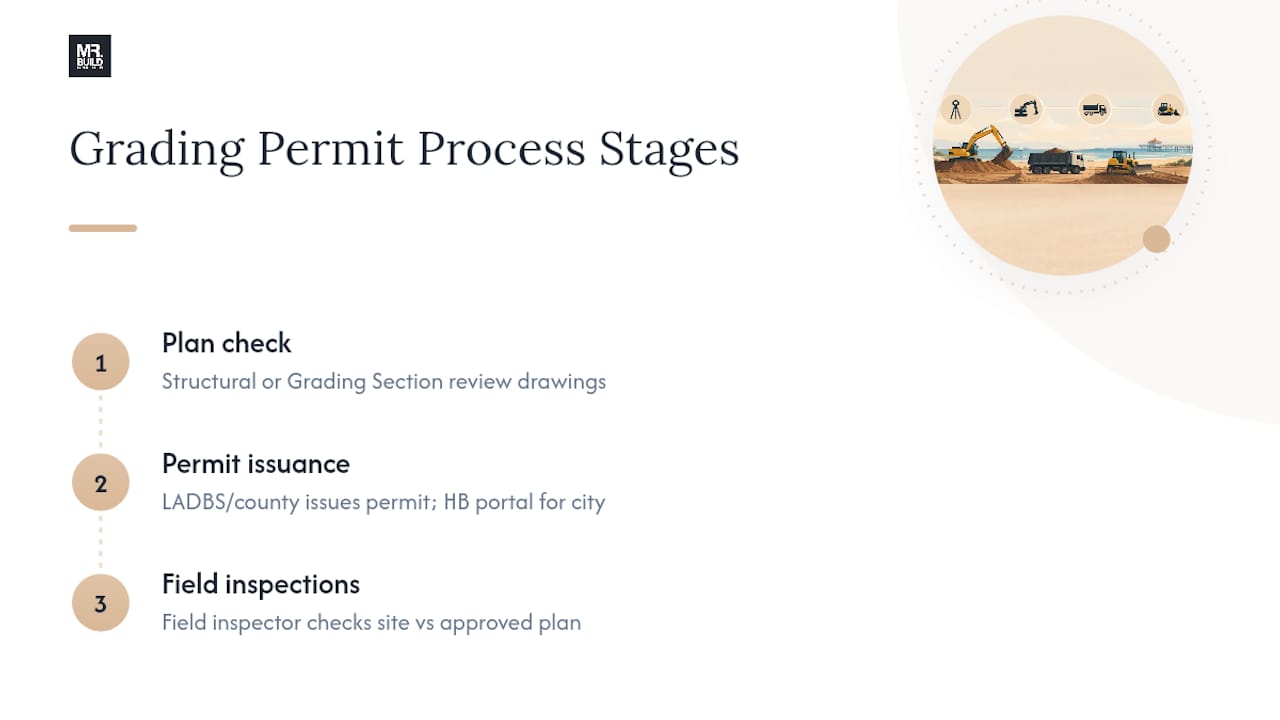

How the LADBS grading process works

  1. Survey and investigation: the surveyor maps the site; the geotechnical engineer and geologist drill borings and write their reports.
  2. Design: the civil engineer prepares grading, drainage and erosion control plans that match the reports and the architect's site plan.
  3. Plan check: LADBS reviews the plans, and in hillside areas the Grading Division reviews the soils and geology reports and issues approval letters with conditions.
  4. Corrections: the team answers reviewer comments and resubmits. Most delays happen here.
  5. Clearances, bond and haul route: any required bond is posted, and a haul route is approved if needed.
  6. Permit issuance: the grading permit is issued, often alongside or just ahead of the building permit.
  7. Inspections and final: grading is inspected in stages, then the soils engineer and geologist submit final reports and the grading is signed off.

Grading often runs in parallel with the building permit for the house or addition. If you are adding on, our guide to addition permits in Los Angeles explains how the building side fits in.

Grading bonds for hillside work

LADBS requires a grading bond for grading of roughly 250 cubic yards or more of cut or fill in a designated hillside area. If your estimate sits close to that number, check the exact wording of the current rule with LADBS, because being just over or under matters.

The bond amount is based on the larger of the excavation or fill volume, plus the cost of drainage devices, retaining walls and other protective work on the plan. It is a financial guarantee: if the work is abandoned or left unsafe, the city can use it to stabilize the site. The bond is released after the grading passes final inspection, so treat it as money committed for the life of the job.

Underestimating quantities is a common mistake. If the real cut or fill turns out larger than the permit shows, you may need a revised permit, a larger bond or a new haul route, all of which cost time.

Haul routes, neighbors and timing

Large hillside export or import needs a haul route approval with a public hearing, and LADBS lists a processing time of at least six weeks. Haul conditions can limit truck hours, routes and staging, which affects the construction schedule and cost.

Excavation near a property line also has neighbor obligations. California's civil code requires reasonable advance notice to adjoining owners before an excavation that could affect their land, and deep cuts may need engineered shoring. Talk to neighbors early; it prevents complaints that bring an inspector to the site.

Typical timeline

StepTypical time
Survey and soils and geology investigation3 to 8 weeks
Grading, drainage and erosion control plans2 to 6 weeks
Plan check and corrections, flatland lotSeveral weeks
Plan check and corrections, hillside lotOften 2 to 4 months or more
Haul route, if requiredAt least 6 weeks, plus hearing

These are estimates. Review times change with workload, and a project with geology questions can take longer.

Inspections, erosion control and permit expiration

Grading is inspected in stages, not just at the end. Inspectors and your soils engineer typically look at the cleared site and erosion controls, the bottom of excavations and keyways, fill placement and compaction, subdrains and drainage devices, and final grades. The soils engineer documents compaction testing and issues a report before final approval.

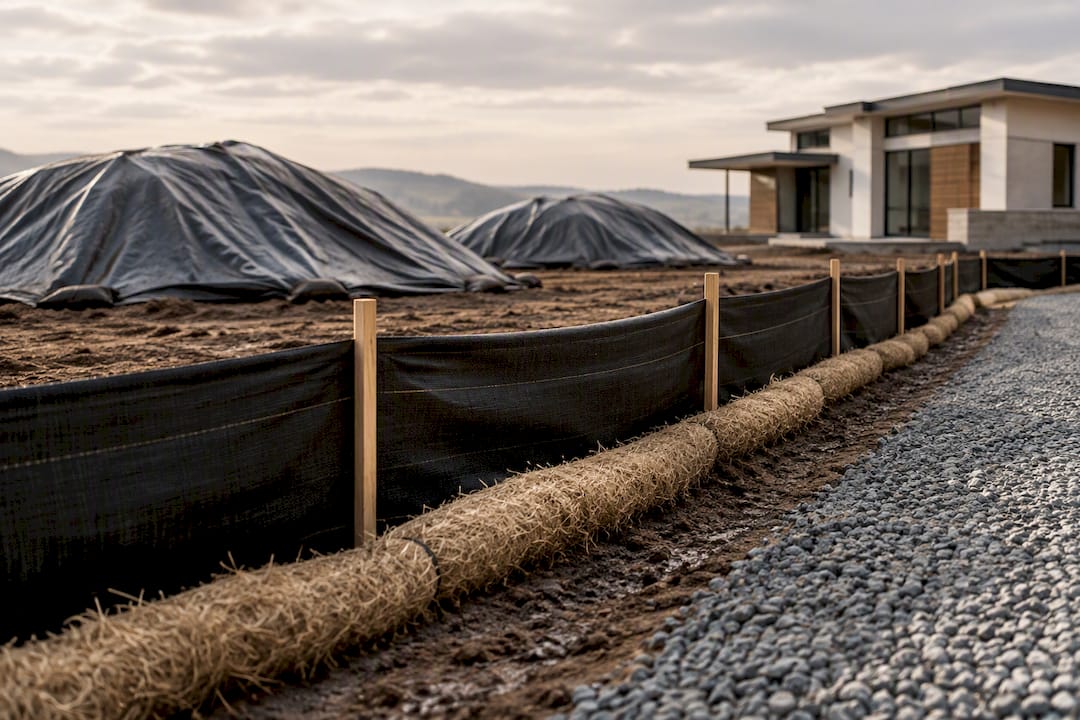

Silt fencing, straw wattles and covered soil around a graded home site to control erosion

Erosion control is part of every grading job: silt fencing, fiber rolls at drainage points, gravel at the construction entrance and plastic over exposed slopes and stockpiles before rain. Grading during the rainy season, roughly late fall through spring, draws closer attention, and a storm can undo weeks of work if controls fail.

Both plan check applications and issued permits expire if too much time passes or work stops for too long. Ask LADBS for the current limits on your permit, schedule inspections as work progresses, and request an extension before a deadline passes rather than after.

Common reasons grading plans get sent back

  • Soils or geology report missing, outdated or not referenced on the plans
  • Cut and fill quantities that do not match the cross-sections
  • Drainage that sends water toward a neighbor or over a slope
  • Grading that exceeds hillside limits for the lot size
  • Site conditions on the plans that do not match the field

Changes discovered during excavation, such as unexpected fill, groundwater or a buried utility, need to go back to the engineer and the plan checker before work continues. A revision approved first is far cheaper than a stop-work order.

How Mr Build helps with grading and site work

On a hillside custom home, a rebuild or a large addition, grading ties directly to the foundation, drainage and the house design, so the survey, soils report, civil plans and architecture need to move together. As a design-build general contractor working in Los Angeles since 1984, Mr Build Co. coordinates that team in-house through our partners, handles the permit submittals, and manages inspections with a dedicated project manager. See our custom home building services and our work as a custom home builder in Pacific Palisades, or read about ADU permits in Los Angeles if grading is part of a backyard unit. When you are ready, schedule a free on-site consultation and we will walk the lot with you.

Sources and further reading

FAQ

Frequently asked questions

Do I need a grading permit to level my backyard in Los Angeles?

It depends on how much soil you move, how deep you cut, whether you add fill and whether the lot is in a hillside area. Small, shallow work on flat ground is often exempt, while anything that changes drainage, supports a retaining wall or sits on a slope usually needs review. Describe the work to LADBS or have a builder check it before you rent equipment.

When is a grading bond required in Los Angeles?

LADBS requires a grading bond for larger grading in designated hillside areas, generally at about 250 cubic yards of cut or fill. The bond amount is based on the volume of earth moved plus the cost of drainage devices, retaining walls and other protective work on the plan. It is released after the grading passes final inspection, so plan for that money to stay committed until then.

How long does a grading permit take in Los Angeles?

A small flatland job with a complete package can clear in weeks. Hillside projects usually take several months once you include the survey, soils and geology investigation, grading plan, plan check and corrections. A haul route approval, needed for large hillside import or export, adds at least six more weeks. Starting the soils work early is the best way to protect the schedule.

What happens if I grade without a permit in Los Angeles?

LADBS can issue a stop-work order and require after-the-fact permits, engineering reports and inspections, which often cost more than doing it right the first time. In some cases the work has to be removed or rebuilt. Unpermitted grading can also surface during a sale or refinance and must be resolved before the deal closes.

From the blog

Keep reading

Modern new home roof fitted with rows of solar panels under a clear sky

Construction & PlanningOctober 12, 2026

California Solar Mandate: When New Homes and ADUs Need Solar

California's energy code requires solar panels on most newly built homes, including many detached ADUs. Most remodels and additions do not trigger it. Here is how to tell which side your project falls on.

Free estimate

Let's talk about your home

Share a few details and we'll set up a visit. We'll look at the space, listen to what you want, and explain how permits, schedule and budget would work for your project.

  • On-site visit with an experienced builder
  • Clear written scope and pricing
