Home Addition Cost in Los Angeles: 2026 Ranges and What Drives Them

Most Los Angeles additions are priced per square foot, but the real number comes from plumbing, structure, site access and soft costs. Here is how to build a realistic budget.

Single-story home addition under construction in Los Angeles with new framing tied into the existing house
In this article
  1. Home addition cost in Los Angeles by project type
  2. Soft costs: design, engineering and permit fees
  3. What drives the cost of an addition in Los Angeles
  4. Los Angeles code and zoning items that change scope
  5. Addition vs. ADU: compare the cost per useful foot
  6. How long an addition takes
  7. How to compare addition bids
  8. Where you can save without cutting corners
  9. How Mr Build helps you price an addition

In 2026, most home additions in Los Angeles cost roughly $350 to $650 per square foot for construction, with second-story additions and kitchen expansions often running higher. A 400-square-foot addition therefore commonly lands somewhere between about $140,000 and $260,000 before design, engineering and permit fees, depending on what goes inside it and how hard the site is to build on.

Those ranges are estimates, not quotes. Two additions of the same size can differ by six figures because of plumbing, structure, lot access and finishes. This guide explains the typical cost ranges by addition type, the soft costs people forget, the Los Angeles code items that change scope and how to compare bids so you know what you are paying for.

Home addition cost in Los Angeles by project type

The type of addition sets the baseline. Rooms with plumbing cost more per square foot than open living space, and building up costs more than building out.

Addition typeTypical 2026 LA-area construction rangeMain cost drivers
Single-story bedroom or family roomAbout $350 to $500 per sq ftFoundation, roof tie-in, windows
Primary suite with bathroomAbout $450 to $650 per sq ftPlumbing, tile, shower waterproofing
Kitchen expansion or bump-outAbout $500 to $750 per sq ftCabinets, appliances, gas and electrical, beam work
Second-story additionAbout $450 to $800+ per sq ftStructural upgrades, stair, roof removal, temporary move-out
Garage conversion to living spaceOften less per sq ft than new spaceSlab, insulation, utilities, egress

Small additions cost more per square foot than large ones, because the fixed costs of a foundation, a roof tie-in, permits and mobilization are spread over fewer feet. A 150-square-foot bump-out can easily price above the top of these ranges.

To turn a per-square-foot range into a working number, multiply it by the planned size, add soft costs, then add your contingency. For example, a 400-square-foot primary suite at $450 to $650 per square foot works out to about $180,000 to $260,000 in construction alone, before fees and before any structural surprises.

Soft costs: design, engineering and permit fees

Construction is only part of the budget. Plan for these items before the first shovel:

  • Architectural design: existing-conditions measurements, floor plans, elevations and construction drawings.
  • Structural engineering: foundation, framing, beams and lateral (seismic) design, plus calculations for plan check.
  • Title 24 energy compliance: the CF1R report, and HERS field verification when HVAC work requires it.
  • Soils report: sometimes required, especially on hillside lots or expansive soil.
  • Survey: useful or required when the addition is near a setback line.
  • Permit and plan check fees: set by the city and based on project valuation.
  • School fees: California school districts can charge developer fees on residential additions larger than 500 square feet.

Together, soft costs often add something like 10 to 20 percent on top of construction. Ask every bidder whether design, engineering and fees are included, because leaving them out is one of the easiest ways to make a bid look low.

What drives the cost of an addition in Los Angeles

Plumbing and kitchens

Every new bathroom, laundry or kitchen adds drain lines, venting, water supply, fixtures, tile and inspections. Locating wet rooms near existing plumbing saves money; running a new drain across a raised foundation or through a slab costs it.

Structure and seismic work

Many Los Angeles houses were built decades ago with foundations and framing that do not match current code. Tying a new addition into an older home may mean new footings, anchor bolts, shear walls, hold-downs and beams where you open the exterior wall. A second story usually requires an engineer to verify that the existing foundation can carry the new load, and often means reinforcing it.

Site access and hillside lots

A flat lot with driveway access lets crews bring in a concrete truck and stage materials. Hillside lots in Brentwood, the Palisades or the hills above Encino may need deeper caissons, retaining walls, a grading permit, a pump truck or materials carried by hand. Those items can shift a budget more than finish choices do.

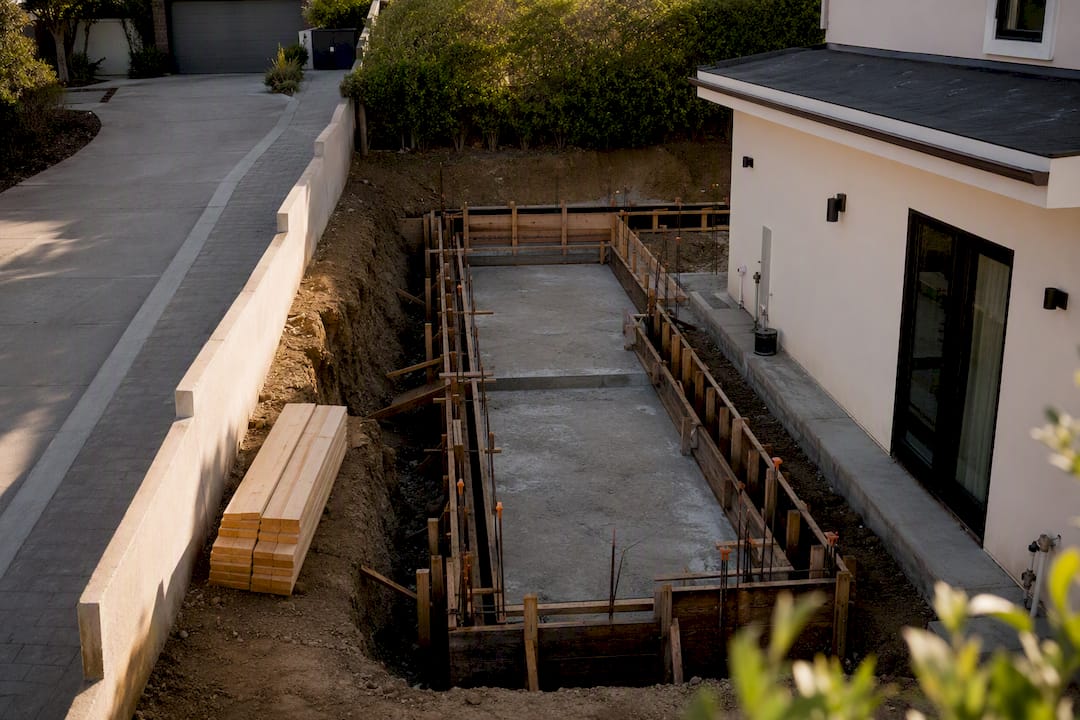

Foundation trench excavated beside an existing house on a tight Los Angeles addition site

Electrical service and HVAC

Added square footage, a heat pump, kitchen appliances or an EV charger can push an older 100-amp panel past capacity. A service upgrade involves the utility and adds both cost and schedule. Extending existing ductwork may not be enough for a large addition; a separate ductless system is often simpler.

Finishes

Flooring, windows, cabinets, tile, plumbing fixtures and lighting are where you control the number. Matching the existing house exactly, such as the same siding profile, roof tile or hardwood species, can also cost more than people expect.

Los Angeles code and zoning items that change scope

In the City of Los Angeles, an addition goes through LADBS plan check and a zoning review. Several items commonly affect what you can build and what it costs:

  • Floor area limits: the city's mansionization rules for single-family zones cap residential floor area based on lot size, with separate hillside rules. An addition that exceeds the limit may need to shrink or go through a discretionary process.
  • Setbacks and height: side, rear and front yard requirements and height limits set the buildable envelope.
  • Energy code: new space must meet Title 24 for insulation, windows, lighting and ventilation, and altering HVAC can trigger duct testing.
  • Fire zones: lots in Very High Fire Hazard Severity Zones need ignition-resistant construction for the addition, such as specific vents, roofing and exterior materials.
  • Fire sprinklers: some larger additions or hillside projects trigger sprinkler requirements. Ask LADBS early.

Our guide to addition permits in Los Angeles walks through the full plan check and inspection sequence.

Addition vs. ADU: compare the cost per useful foot

If the goal is space for a parent, an adult child or rental income, price an ADU alongside the addition. A detached ADU can cost more because it needs its own kitchen and utility connections, but state law exempts many ADUs from the floor area and parking limits that constrain additions, and an ADU can produce rent. An attached addition, on the other hand, adds directly to the main home's living space. Our ADU vs. home addition comparison sets the trade-offs side by side.

How long an addition takes

PhaseTypical duration
Site visit, scope and budget1 to 3 weeks
Design, engineering and Title 241 to 3 months
Plan check and permit1 to 4 months, longer on hillside lots
Construction, single-story3 to 6 months
Construction, second story5 to 9 months

A longer schedule costs money too, especially if you rent elsewhere during a second-story job. Order long-lead items, such as windows and cabinets, as soon as the design is final.

How to compare addition bids

The lowest number rarely tells you the most. A useful bid is itemized and built on the same scope as the others. Ask each contractor to break out:

  1. Design, engineering and permit fees, or a clear statement that they are excluded
  2. Site work, demolition and foundation
  3. Framing, roofing and exterior finishes
  4. Plumbing, electrical and HVAC
  5. Interior finishes, with allowances for items not yet selected
  6. Contingency, and how unused contingency is handled

Then check the contract basics. Verify the license, bond and workers' compensation coverage at cslb.ca.gov. California limits the down payment on a home improvement contract to $1,000 or 10 percent of the price, whichever is less. Progress payments should follow completed work, not the calendar, and each one should come with a lien release.

Keep a contingency of your own, often 10 to 15 percent for an addition to an older house, for conditions found when the exterior wall comes off and for upgrades you choose along the way.

Where you can save without cutting corners

Some savings are real and some just move cost to later. These usually hold up:

  • Keep the footprint simple. A rectangle with one roof plane tied into the existing roof costs less to frame, flash and waterproof than a shape with several corners and valleys.
  • Stack or cluster wet rooms. Put the new bathroom next to an existing bathroom, kitchen or laundry so drains and supply lines stay short.
  • Reuse openings. Turning an existing window into a doorway into the addition usually costs less than cutting a new opening in a bearing wall.
  • Use standard sizes. Stock window sizes, standard cabinet widths and common tile formats cost less and arrive sooner than custom items.
  • Decide early. Finalizing selections before construction avoids change orders, which are the most expensive way to buy anything on a job.
  • Combine scopes wisely. If you were going to redo an adjacent bathroom or reroof soon, doing it with the addition saves a second mobilization and a second set of permits.

What not to cut: engineering, waterproofing, flashing, insulation and the contingency. Problems in those areas show up after the drywall is painted, when they cost the most to fix.

How Mr Build helps you price an addition

Mr Build Co. is a design-build contractor that has been building additions and remodels across Los Angeles and Orange County since 1984. We start with a free on-site consultation to look at the foundation, the panel, the plumbing routes, access and the zoning envelope. Design, engineering and permits are handled in-house through our partners, and you get a fixed, detailed written scope and price before construction begins, with a dedicated project manager through the final walkthrough. Learn about our ADU and home addition services or our work as a room addition contractor in Encino, then book a free consultation to get a number based on your house.

Sources and further reading

FAQ

Frequently asked questions

How much does a 400-square-foot addition cost in Los Angeles?

Using typical 2026 LA-area ranges, a 400-square-foot single-story bedroom or family room might run roughly $140,000 to $200,000 in construction, and a primary suite with a full bathroom more like $180,000 to $260,000. Design, engineering and permit fees come on top. These are planning estimates only; a site visit and a written scope are the only way to get a real number for your house.

Is it cheaper to build up or out in Los Angeles?

Building out on a single story is usually cheaper per square foot because the existing structure does not have to carry new load. A second story needs engineering of the existing foundation and framing, a new stair, roof removal and often seismic upgrades, and you may need to move out during part of the work. Going up makes sense when the lot has no room to expand or zoning limits the footprint.

Do I need a permit for a home addition in Los Angeles?

Yes. Any addition of habitable space needs a building permit, and in the City of Los Angeles that means plan check with LADBS plus a zoning review for setbacks, height and floor area limits. Inspections follow at the foundation, framing, rough trades, insulation and final stages. Unpermitted additions can lead to fines, removal orders and problems when you sell.

How much should I pay a contractor up front for an addition?

For home improvement contracts in California, the down payment is limited by law to $1,000 or 10 percent of the contract price, whichever is less. After that, payments should follow completed work, such as foundation, framing or rough inspections, rather than calendar dates. Ask for conditional lien releases with each progress payment and verify the contractor's license with the CSLB before signing.

From the blog

Keep reading

Modern ADU behind a West Hollywood home with a car parked in the driveway

ADUs & AdditionsOctober 20, 2026

West Hollywood ADU Parking Rules: What You Need to Know

West Hollywood does not require off-street parking for an ADU, even when you convert the garage. The real decisions are about your own cars, your future tenant and the street outside.

Free estimate

Let's talk about your home

Share a few details and we'll set up a visit. We'll look at the space, listen to what you want, and explain how permits, schedule and budget would work for your project.

  • On-site visit with an experienced builder
  • Clear written scope and pricing
