Construction Change Orders: What They Are and How to Handle One

A change order is the signed document that changes your contract's scope, price or schedule. Here is how they work on a remodel, how they are priced and how to keep them under control.

Contractor holding a tablet with a change order while overlooking open kitchen wall framing
In this article
  1. What Counts as a Construction Change Order?
  2. Why Change Orders Happen
  3. The Change Order Process, Step by Step
  4. What Every Change Order Should Include
  5. How Change Orders Are Priced
  6. Schedule Impacts Are Real Costs
  7. When Change Orders Turn Into Disputes
  8. How to Keep Change Orders Under Control
  9. Change Orders on ADUs, Additions and Custom Homes
  10. How Mr Build Handles Change Orders

A construction change order is a written, signed amendment to your contract that changes the scope of work, the price, the schedule or all three. It should be approved by both you and the contractor before the changed work happens, not after. Once signed, it becomes part of the contract, so the new price and completion date are as binding as the original agreement.

Change orders are normal on remodels, ADUs and custom homes. Problems start when they are verbal, vague or priced after the fact. This guide explains why change orders happen, what a good one includes, how they are priced and how to keep them from derailing your budget.

What Counts as a Construction Change Order?

Any change to what the contract says you are buying should go through a change order. Most fall into three types:

  • Addition: new work, such as adding recessed lights in a hallway that was not in the plan, or extending a shower to a second wall of tile.
  • Deletion: work removed from the scope, such as dropping a planned pantry, usually with a credit back to you.
  • Substitution: one product or method replaces another, such as quartzite counters in place of the quartz in the original scope.

There is also a gray area. Sometimes work changes without anyone formally asking, for example when you delay a decision and the crew has to return later, or when the inspector requires something not shown on the plans. These still affect cost and time, so they still need a written change order.

The California rule

Under California's home improvement contract rules, changes to the scope or price must be in writing and signed by both parties before the work is performed. The change order should describe the work, the cost and the effect on the schedule. A text message saying "go ahead" is not a change order.

Why Change Orders Happen

Even well-planned projects see some changes. The common causes:

  • Owner requests: upgrades, layout tweaks and new ideas once you see the space framed
  • Hidden conditions: rot, termite damage, undersized framing, old wiring or failing drain lines found when walls and floors open up
  • Design gaps: details the drawings did not resolve, or conflicts between trades
  • Code and inspection requirements: an inspector calls for an upgrade, such as additional smoke alarms or electrical work when circuits are extended
  • Product availability: a selected item is discontinued or back-ordered, forcing a substitution

Older Los Angeles and Orange County homes are especially prone to hidden-condition changes. Galvanized plumbing, ungrounded wiring and decades of past repairs often show up only after demolition.

Worker photographing an opened kitchen wall to document a hidden condition before a change order

The Change Order Process, Step by Step

A clear sequence protects both you and the contractor:

  1. Identify the change. You ask for something new, or the contractor finds a condition. The contractor photographs it and notes the date and location.
  2. Get a written proposal. The contractor describes the change in plain language, references the affected plan sheet or scope item, and lists the price and schedule impact.
  3. Review and ask questions. Make sure you understand what is included, whether there are alternatives, and how the change affects other work.
  4. Approve or decline in writing. Sign only when the description, price and schedule match your understanding. If you decline, note it in writing too.
  5. Update the budget and schedule. The new contract total and completion date should be reflected right away, and the change added to your project record.

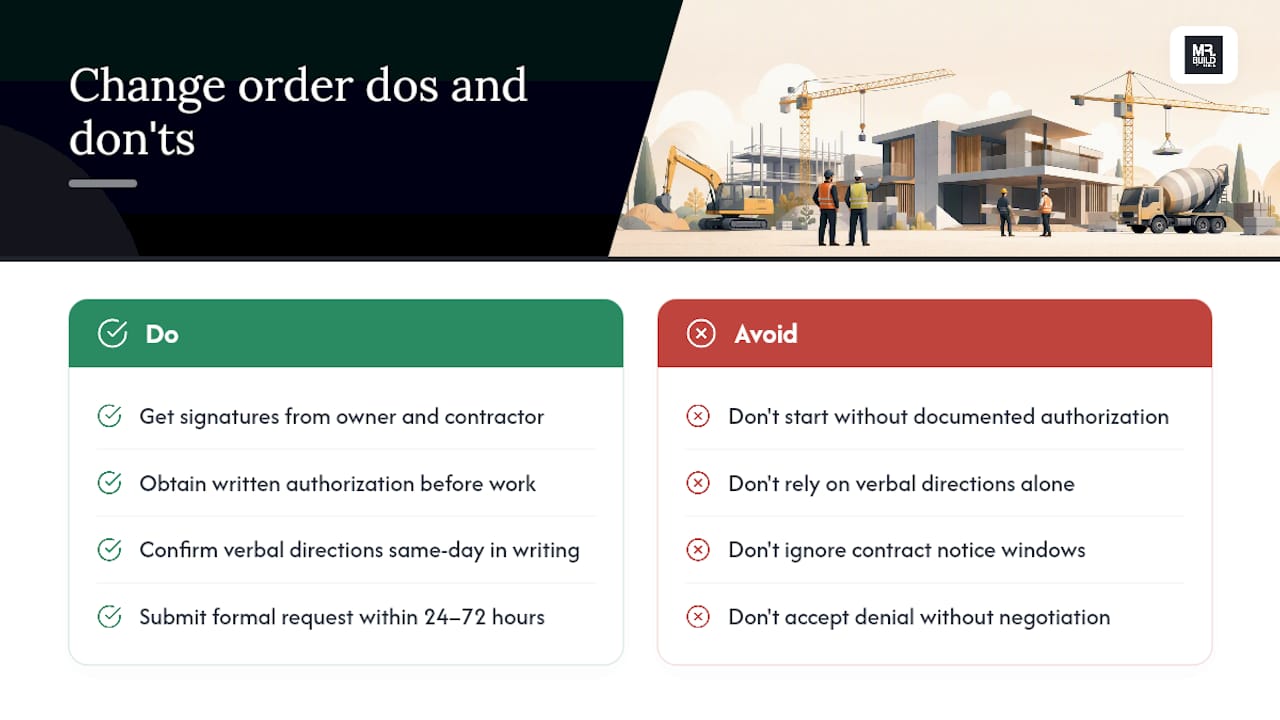

The key is step 4 happening before the work, not after. That one habit prevents most change order disputes.

What Every Change Order Should Include

A good change order is specific enough that someone who was not in the conversation could understand it. At minimum:

  • Project address, date and a change order number
  • A clear description of the work (not "misc. extras")
  • The scope item, drawing or selection it changes
  • The price, with a breakdown of labor, materials and markup when the amount is significant
  • Any credit for work removed
  • The effect on the schedule in days and the revised completion date
  • The new contract total
  • Signature and date lines for you and the contractor

Attach supporting photos for hidden conditions. If you are ever in a dispute, dated photos and signed paperwork carry far more weight than memory.

How Change Orders Are Priced

Your contract should say how changes will be priced. These are the common methods:

MethodHow it worksBest forWatch out for
Fixed price (lump sum)One agreed price for the change before work startsMost owner-requested changesMake sure the scope of the change is fully described
Unit priceA set rate per unit, such as per square foot of tile or per linear foot of pipeChanges where quantity is uncertain, like rot repairAgree on how quantities will be measured
Time and materialsActual labor hours and material costs plus markupSmall or truly unknown workCosts are open-ended; ask for daily records
Time and materials with a capTime and materials up to a not-to-exceed amountHidden conditions where you need a ceilingAgree in writing what happens if the cap is reached

Most change orders include a markup for the contractor's overhead and profit. That is fair; the contractor is managing, scheduling and warrantying the added work. The contract should state the markup rate so it is not negotiated fresh each time.

The type of contract you sign shapes how changes play out. Our comparison of cost-plus vs. fixed-price contracts explains how each one handles changes and overruns.

Who pays

In general, you pay for changes you request and for hidden conditions the contract excludes. The contractor pays to correct its own errors and for work that was clearly in the original scope. Unforeseen conditions are where disputes happen, so read the contract's language on them before you sign.

Schedule Impacts Are Real Costs

A change rarely affects only the item being changed. Adding a window can mean new framing, a revised header, an inspection, a longer lead time and a delay to drywall. Ask for the schedule impact on every change order, including:

  • Direct time: the days needed to do the added work
  • Lead time: how long new materials take to arrive
  • Knock-on delays: trades that cannot proceed until the change is done, and any re-inspection

Late changes cost the most. Moving a sink before rough plumbing is a drawing revision; moving it after tile is demolition and rework.

When Change Orders Turn Into Disputes

Most change order disputes come from the same few situations:

  • Work started on a verbal approval, then priced later
  • Vague descriptions that each side reads differently
  • No price or schedule impact stated
  • A pile of small changes nobody totaled until the final invoice
  • Slow decisions by the owner that stall the crew

If a disagreement starts, keep it factual. Gather the contract, the change orders, photos and messages. Ask for a meeting with the project manager. Put your position in writing with the specific contract language you are relying on. If your contract includes mediation or arbitration, that clause sets the next step.

Good communication habits prevent most of this. See our guide on how to communicate with your contractor for a simple meeting and record-keeping routine.

How to Keep Change Orders Under Control

You will probably have some change orders. You can keep them few and predictable:

  1. Finish design before construction. Complete drawings and make your selections, down to faucets and tile, before the contract is priced.
  2. Ask for a detailed scope. Line items with inclusions and exclusions leave less room for surprise.
  3. Investigate known risks. A sewer camera inspection, a look in the attic or a small exploratory opening can reveal problems before pricing.
  4. Keep a contingency. A common rule of thumb is to hold back roughly 10 percent of the construction budget for an older home, and more for major structural work.
  5. Decide on time. Late decisions create delays, and delays create cost.
  6. Batch small ideas. Collect minor requests and review them together in your weekly meeting instead of one by one on site.
  7. Track the running total. Keep a log of approved change orders and the updated contract amount.

Change Orders on ADUs, Additions and Custom Homes

Bigger projects bring more chances for change, and some come from the city rather than from you. Plan check corrections, a revised structural detail or a utility company requirement can all change the work after the contract is signed. Ask your contractor up front how plan revisions requested by the city will be priced.

Site work is the other big source. Soil conditions, buried lines, tree roots and drainage often are not fully known until excavation starts. A soils report before pricing, and a clear contract clause on unforeseen site conditions, keep these changes from becoming arguments.

Finally, keep an eye on long-lead items. A window or door substitution late in the job can ripple through framing, waterproofing and inspections, so lock those selections early.

How Mr Build Handles Change Orders

Mr Build starts every project with a fixed, detailed written scope and pricing, built after design, engineering and selections are worked out, so fewer decisions are left open once construction begins. When a change does come up, your dedicated project manager documents it, explains the price and schedule impact in writing and waits for your signed approval before the work proceeds.

Learn how this works on our complete home remodeling projects, or as a home remodeling company in Brentwood. To plan a project with fewer surprises, schedule a free on-site consultation.

Sources and further reading

FAQ

Frequently asked questions

What is a change order in construction, in simple terms?

A change order is a written amendment to your construction contract that changes the work, the price, the completion date or a combination of them. Both you and the contractor sign it before the changed work starts, and once signed it becomes part of the contract. In California, changes to a home improvement contract should always be handled this way.

Who pays for a change order?

It depends on why the change happened. Upgrades and additions you request are paid by you. Hidden conditions, such as rot or old wiring found behind a wall, are usually the owner's cost unless the contract says otherwise. Contractor mistakes or items the contractor missed in a clearly defined scope are normally the contractor's responsibility to fix at no charge.

Can a contractor start extra work before a change order is signed?

They should not, except for a genuine emergency such as stopping a leak or making a structure safe. Even then, the contractor should document the situation with photos the same day and send a written change order promptly. As a homeowner, do not approve extra work verbally; ask for the written change order first.

How can I avoid change orders on my remodel?

You cannot avoid every one, but you can cut most of them. Finish design and selections before construction, ask for a detailed fixed scope with clear inclusions and exclusions, investigate known risks such as old plumbing before pricing, keep a contingency in your budget and make decisions by the dates in your schedule.
