How Much Does a Curbless Shower Cost in 2026?

Most mid-range curbless showers run about $10,000 to $15,000. Here is where that money goes, what pushes a project higher, and how to read a bid before you sign.

Curbless walk-in shower with a frameless glass panel and large-format floor tile running level into the bathroom
In this article
  1. Curbless shower cost by tier
  2. Where the money goes, line by line
  3. Why the floor is the biggest cost variable
  4. Foam tray or mortar bed: which costs more?
  5. How to get an accurate curbless shower estimate
  6. Timeline and permits
  7. What accessibility features add to the budget
  8. Long-term costs: upkeep and the price of a failure
  9. How Mr Build plans and prices a curbless shower

A mid-range curbless shower typically costs about $10,000 to $15,000. Simpler prefab installs can start near $6,000, and natural stone builds with custom glass often pass $25,000. In the Los Angeles area, higher labor rates tend to push projects toward the upper half of each range.

The curbless shower cost premium over a standard shower comes from work that ends up hidden: lowering or building up the floor, a continuous waterproofing membrane, a linear drain, and tile set to an exact slope with no lip to catch mistakes. Below is how those pieces add up, what changes the number on your project, and the questions that separate a solid bid from one that turns into change orders.

Curbless shower cost by tier

Square footage matters less than what sits under the tile. A curb gives water a wall to stop against. Without one, the floor structure has to carry the whole slope, and how hard that is to achieve in your house drives most of the price difference between tiers.

TierTypical range (estimate)What it usually includes
Basic$6,000 to $9,000Prefab curbless base or foam tray, porcelain or subway tile, simple drain, framed or basic glass
Mid-range$10,000 to $15,000Recessed floor or mortar bed, linear drain, full-height porcelain walls, frameless panel or door, roughly 4 by 6 feet
Premium$16,000 to $25,000+Natural stone or large-format slab tile, heated floor, bench and niches, custom frameless glass, larger footprint

These are typical ranges for the shower only, not the whole bathroom, and they are not a quote for any specific contractor's work. A real number comes from someone looking at your floor framing or slab in person.

Compared with a curbed shower using the same tile and glass, the curbless version often adds roughly $3,000 to $8,000. The gap is smaller on a slab that is easy to recess and a simple rectangular layout. It is larger in a second-floor bathroom where joists have to be lowered or reinforced.

Where the money goes, line by line

A curbless shower is really several small projects stacked on top of each other. Any one of them can blow the budget if a bid leaves it vague.

Line itemTypical rangeWhat moves the number
Demolition and disposal$500 to $1,500Whether the old pan and wall tile come out to the studs
Floor recess or slab work$1,000 to $4,000Joist direction, joist size, slab type, access from below
Waterproofing system$800 to $2,500Foam tray, mortar bed, sheet or liquid membrane
Drain and plumbing$400 to $1,800Linear vs. point drain, how far the drain line moves
Tile, materials and labor$3,000 to $8,000Porcelain vs. stone, tile size, wall height, pattern
Glass$800 to $3,000Fixed panel vs. door, glass thickness, custom sizing
Extras$500 to $3,000Niches, bench, heated floor, grab bar blocking

A sample mid-range budget

Here is how a common 4 by 6 foot curbless shower on a mortar bed might break down. Your numbers will differ, but the proportions are typical.

  • Demolition and haul-away: about $900
  • Recessing the subfloor: about $2,200
  • Mortar bed and bonded membrane: about $1,600
  • Linear drain and plumbing changes: about $1,100
  • Porcelain tile and setting labor: about $5,200
  • Frameless glass panel: about $1,800
  • One recessed niche: about $400

That comes to roughly $13,200, squarely in the mid-range tier. Notice that tile is the largest single line, but the floor and waterproofing together are close behind, and those are the lines most likely to grow once demolition starts.

Why the floor is the biggest cost variable

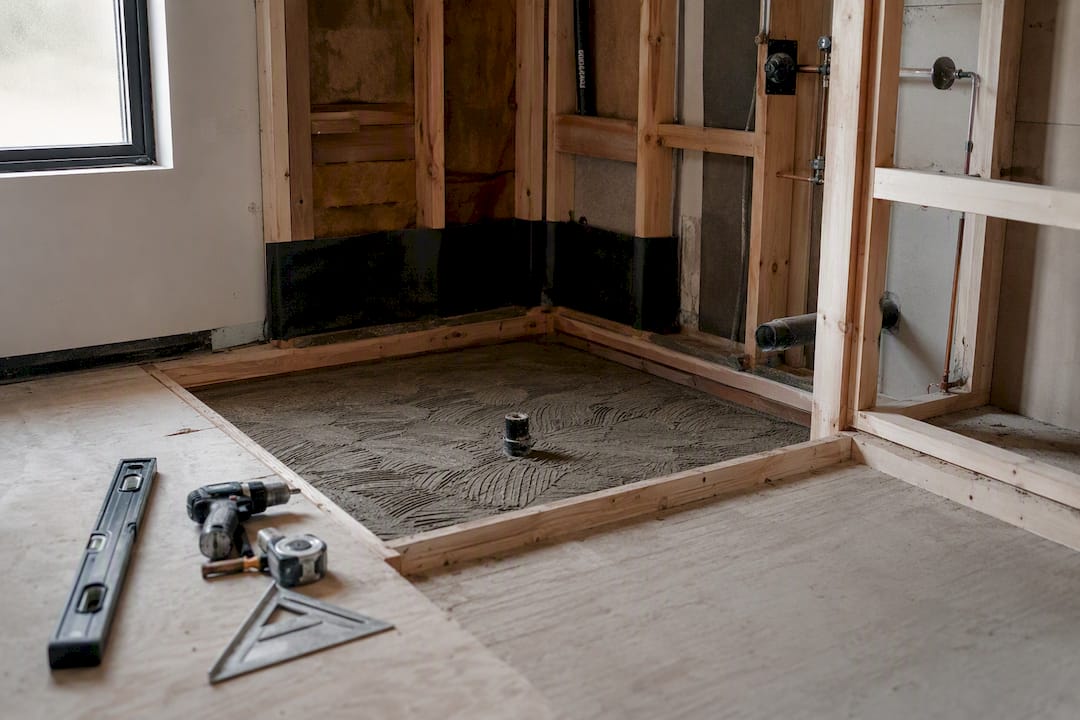

Subfloor lowered between floor joists to create a recessed base for a curbless shower

To get water flowing to the drain without a curb, the shower floor usually needs to sit about 1.5 to 2 inches below the surrounding bathroom floor, depending on the system. How you get that depth depends on what your house is built on.

Wood-framed floors

On a raised foundation or an upper floor, the options are to lower the subfloor between the joists, reframe or reinforce the joists, or raise the rest of the bathroom floor to meet the shower. Cutting into joists is structural work and should be reviewed by an engineer. Raising the bathroom floor avoids the joists but creates a step at the bathroom door that has to be handled with a threshold or by raising the adjoining floor too.

Joist direction matters more than most people expect. If the joists run the wrong way for the slope or the drain line, the plumber may have to reroute around framing, which adds hours on both trades.

Concrete slabs

On a slab, the shower area is saw-cut, removed and re-poured lower, with the drain line adjusted underneath. That is noisy, dusty work but fairly predictable. The big exception is a post-tensioned slab, which is common in many newer tract homes in Orange County. Those slabs contain tensioned steel cables, and cutting one without scanning and an engineer's approval is dangerous. If your slab is post-tensioned, expect a shallower recess, a thinner tray system, or a raised bathroom floor instead.

Second-floor bathrooms

Upstairs, the ceiling below often has to be opened for framing and drain work, then patched and painted. Budget for that drywall work and plan for the room underneath to be out of use for a few days.

Foam tray or mortar bed: which costs more?

The waterproofing approach changes both the price and the risk, and it is where surprise change orders often start.

  • Foam pre-sloped trays and panels (from manufacturers such as Schluter and Wedi) cost more in materials but install faster. Because the slope is built in, they often need less floor depth, which can mean less joist or slab work.
  • Mortar beds (also called drypack) cost less in materials but take more skilled labor, since a tile setter floats the slope by hand. They suit irregular shapes, curved entries and large showers that a rigid tray will not fit.

In practice, mortar bed systems often land at the higher end of the total cost range because of labor, while foam systems sit lower. The right choice depends on your floor depth and shower shape, not on habit. Our guide to curbless shower waterproofing explains how each system is sequenced and tested.

Most open curbless layouts use a linear drain, which lets the floor slope in one direction instead of toward a center point. That single plane makes large-format tile easier to set and keeps water from creeping toward the bathroom floor. Linear drains cost more than point drains, and that difference is part of the curbless premium.

How to get an accurate curbless shower estimate

Bids for the same shower can vary widely because contractors scope the floor work differently. A few steps make bids comparable.

  1. Document what you have. Photograph the existing shower, note whether you are on a slab or a raised floor, and, if you have crawlspace access, note which way the joists run.
  2. Ask for a line-item scope, not a lump sum. Floor work, waterproofing, drain, tile labor and glass should each be priced separately.
  3. Get products named. The bid should name the membrane or tray system and the drain model. A line that says only "waterproofing" tells you nothing.
  4. Put the flood test in writing. The scope should require a documented water test of the shower floor before any tile is set.
  5. Question vague lines. An entry like "shower prep, $2,500" needs a breakdown before you sign.
  6. Ask who owns the sequence. When the plumber, tile setter and glass installer each work separately, nobody is responsible for the waterproofing from start to finish.

Timeline and permits

The shower portion of a remodel usually takes two to three weeks of working days:

  • Demolition: one to two days
  • Floor framing or slab recess: two to four days
  • Drain and plumbing rough-in: one to two days
  • Waterproofing, curing and flood test: three to five days
  • Tile and grout: three to five days
  • Glass: one to two days, after a measuring visit and fabrication time

Most curbless conversions need a permit because they move a drain, change framing or cut a slab. In Los Angeles, Brentwood, Encino and Pacific Palisades, that means LADBS. Beverly Hills, Santa Ana, Irvine and the other cities in the region run their own building departments. Inspection waits and custom glass lead times are the usual reasons a two-week shower becomes a four-week one. Our bathroom remodel timeline shows how the shower fits into the larger schedule.

What accessibility features add to the budget

A zero-threshold entry is not the same thing as an accessible shower. If someone in the household uses a walker or wheelchair now, or may later, a few details add cost.

  • Clear floor space. A shower that a wheelchair can roll into needs a larger footprint than a typical 3 by 5 alcove; accessibility standards use 30 by 60 inches as a minimum for roll-in showers. Expanding the footprint can mean moving a wall or the vanity, which is a bathroom layout cost rather than a shower cost.
  • Grab bar blocking. Solid backing inside the wall typically adds a few hundred dollars when planned before tile. Retrofitting it after the walls are finished can cost several times more.
  • A bench. A built-in or fold-down seat often adds $300 to $900.
  • Slip-resistant tile. Textured or matte finishes rarely add more than a few hundred dollars on a standard shower.

For more on planning a bathroom for the long term, see our aging-in-place bathroom guide.

Long-term costs: upkeep and the price of a failure

A well-built curbless shower costs no more to maintain than a curbed one. Cement-based grout in the wet area benefits from periodic sealing, and large-format tile or epoxy grout cuts that upkeep down. The linear drain channel needs a quick cleaning every so often to keep hair and soap from slowing it.

The real long-term risk is a membrane that fails under the tile. There is no patching a failed waterproofing layer from above, so the repair usually means tearing out the tile and rebuilding the floor, often $4,000 to $10,000 or more depending on tile and size. That is why the flood test before tile is the cheapest insurance in the whole project.

How Mr Build plans and prices a curbless shower

Mr Build has been remodeling Southern California homes since 1984. A curbless shower project starts with a free on-site consultation, where we look at the floor structure, the drain location and the room layout before talking about tile. That visit decides whether a foam system or a mortar bed makes sense, and whether the floor work is simple or structural.

From there, design, engineering when it is needed, and permits are handled through our in-house process and partners. You get a fixed, detailed written scope and pricing, so the floor work and waterproofing are spelled out before construction, and a dedicated project manager keeps the plumber, tile setter and glass installer on one sequence. Learn more about our bathroom remodeling services or see how we approach bathroom remodeling in Beverly Hills. When you are ready, schedule a free consultation and we will walk your bathroom with you.

Sources and further reading

FAQ

Frequently asked questions

Is a curbless shower worth the extra cost?

For many households, yes. A curbless shower removes a trip hazard, makes the bathroom feel larger and lets you age in place without a second remodel later. The extra cost buys floor work and waterproofing you never see, so it only pays off if that hidden work is done well. If nobody in the home needs step-free access and the floor is hard to recess, a low-curb shower can be a sensible middle ground.

Can you build a curbless shower on a second floor?

Usually, but it costs more. The shower area has to drop below the surrounding floor, which means lowering the subfloor between joists, reinforcing or reframing joists, or raising the rest of the bathroom floor. The ceiling below is often opened for access. Any change to joists should be reviewed by an engineer, and the work normally needs a building permit and inspection.

Do I need a permit for a curbless shower in Los Angeles?

In most cases, yes. Moving a drain, changing floor framing or cutting a slab is permitted work. In the City of Los Angeles that permit comes from LADBS; cities such as Beverly Hills, Irvine and Santa Ana issue their own through their building departments. Expect inspections at rough plumbing and before the walls and floor are closed, and confirm the exact sequence with your city.

How long does a curbless shower take to build?

The shower itself usually takes about two to three weeks of working time: demolition, floor framing or slab work, drain rough-in, waterproofing and curing, tile, and glass. Inspections, custom glass lead times and permit review can add to that. If the shower is part of a full bathroom remodel, plan around the bathroom schedule rather than the shower alone.

From the blog

Keep reading

Free estimate

Let's talk about your home

Share a few details and we'll set up a visit. We'll look at the space, listen to what you want, and explain how permits, schedule and budget would work for your project.

  • On-site visit with an experienced builder
  • Clear written scope and pricing
  • Design, engineering and permits handled for you
